RA Solar Rooftop Solar Project has been done with N – Customer
In Tamilnadu places.
- 500kw Space Textiles – Covai
- 200kw KPR Mill – Kaniyur , Coimbatore
- 34.88Kw PRM Lodge – Erode
- 40kw Sri Nachammal Vidyavani School CBSE – Avinashi, Tiruppur

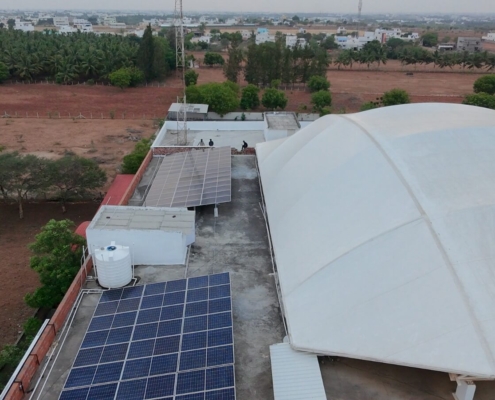

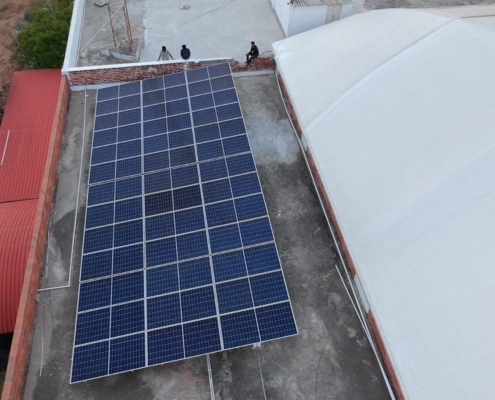

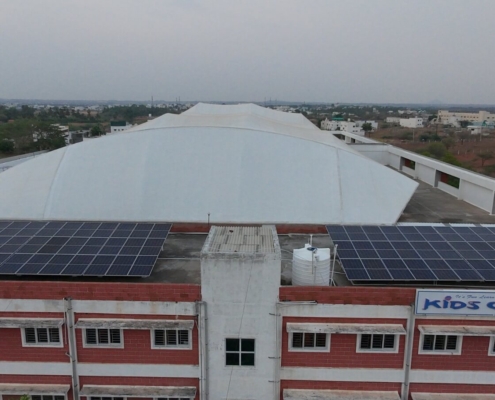

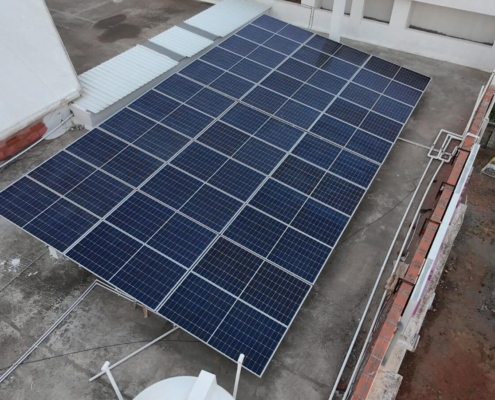

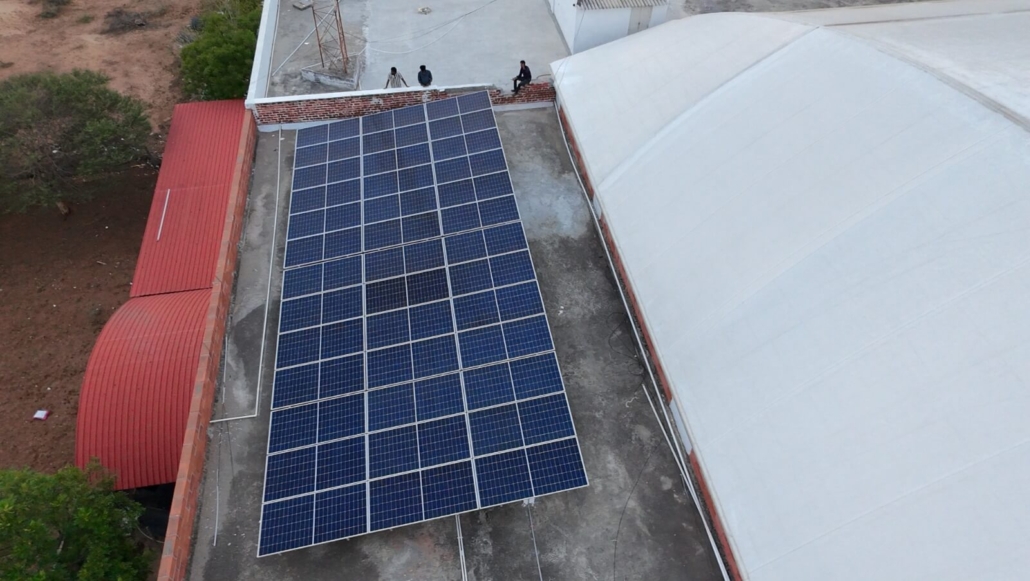

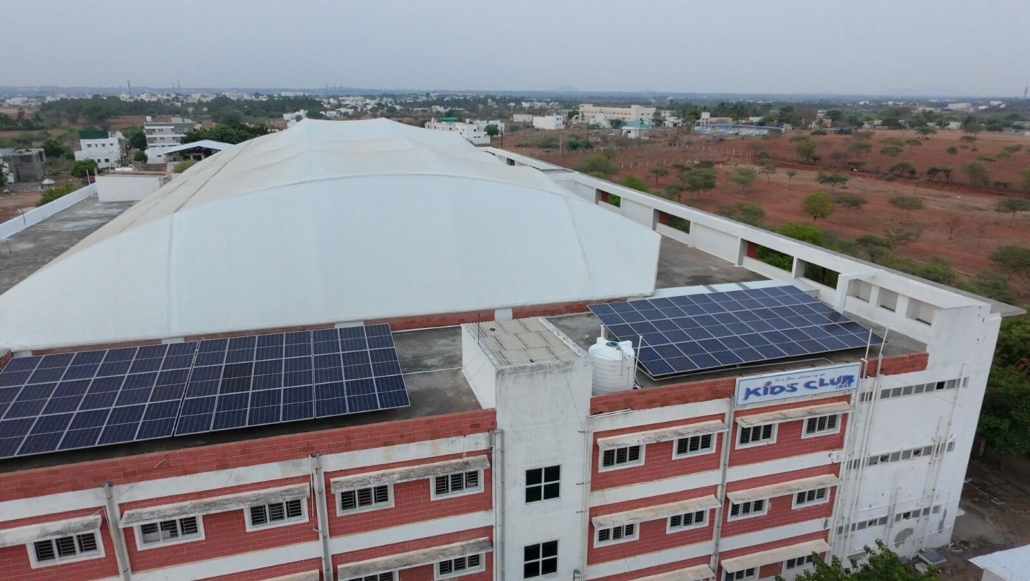

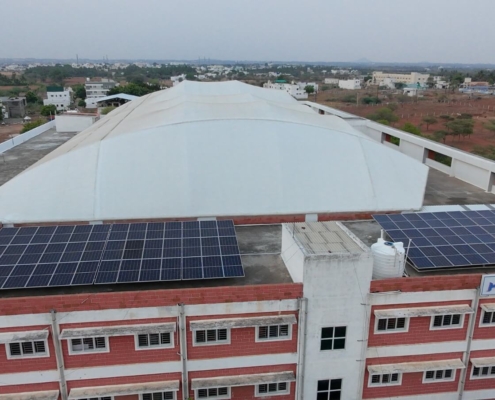

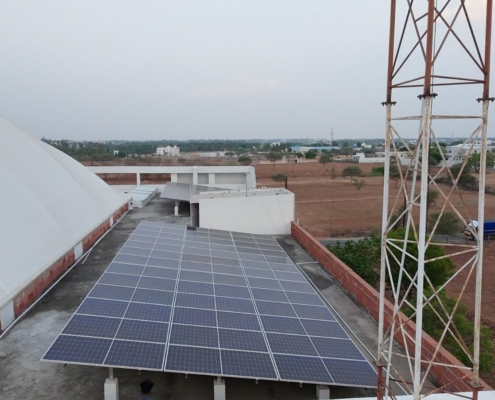

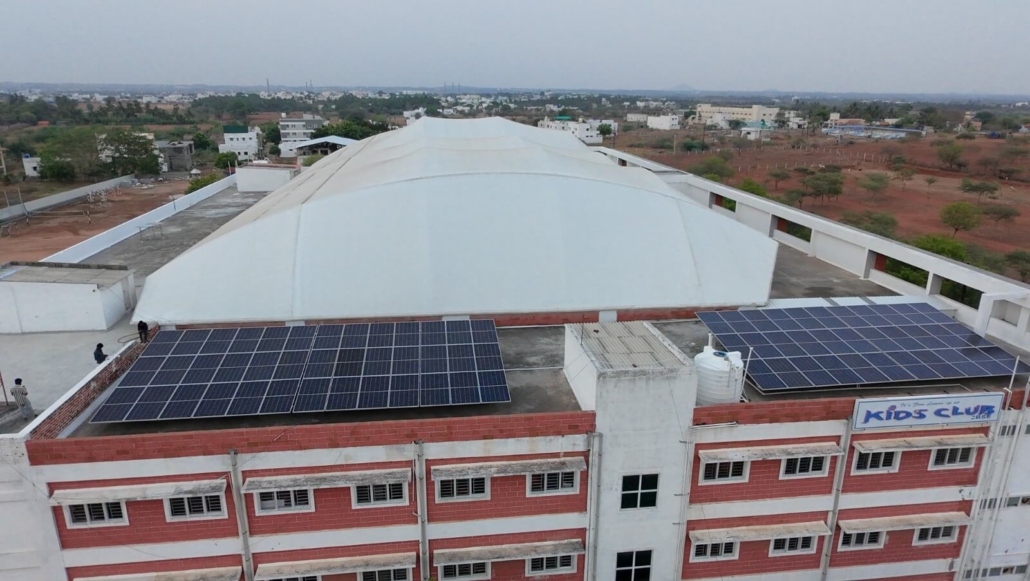

- 40kw Kids Club CBSE school – Vijayapuram , Tiruppur

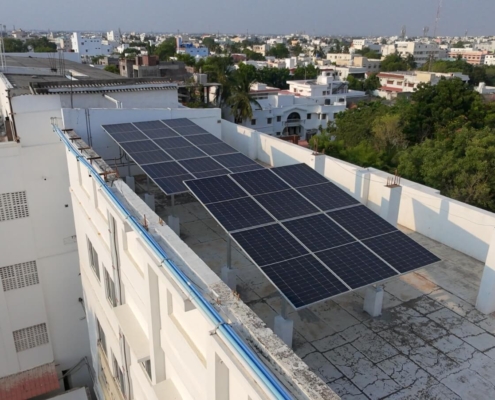

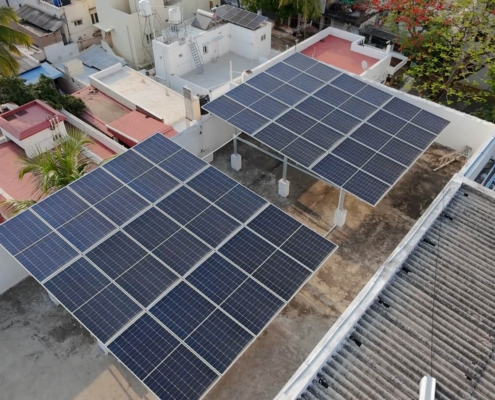

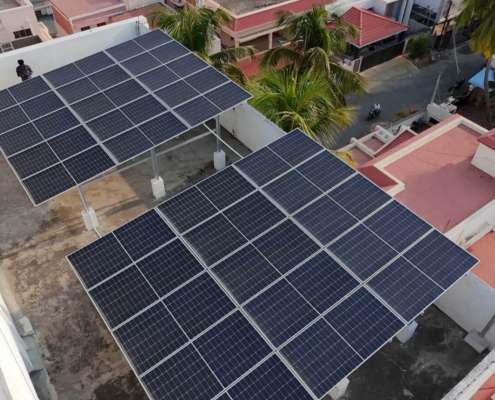

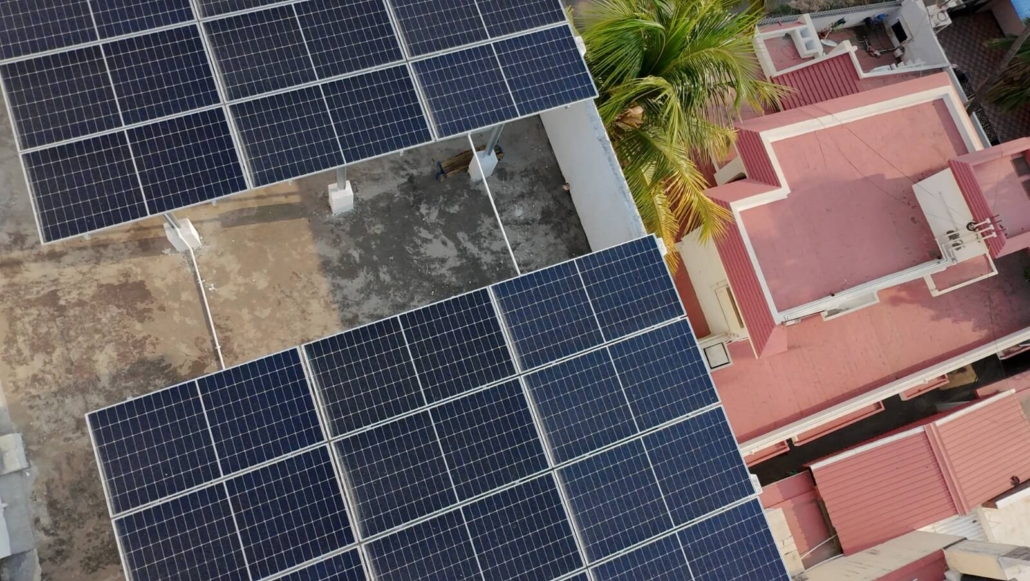

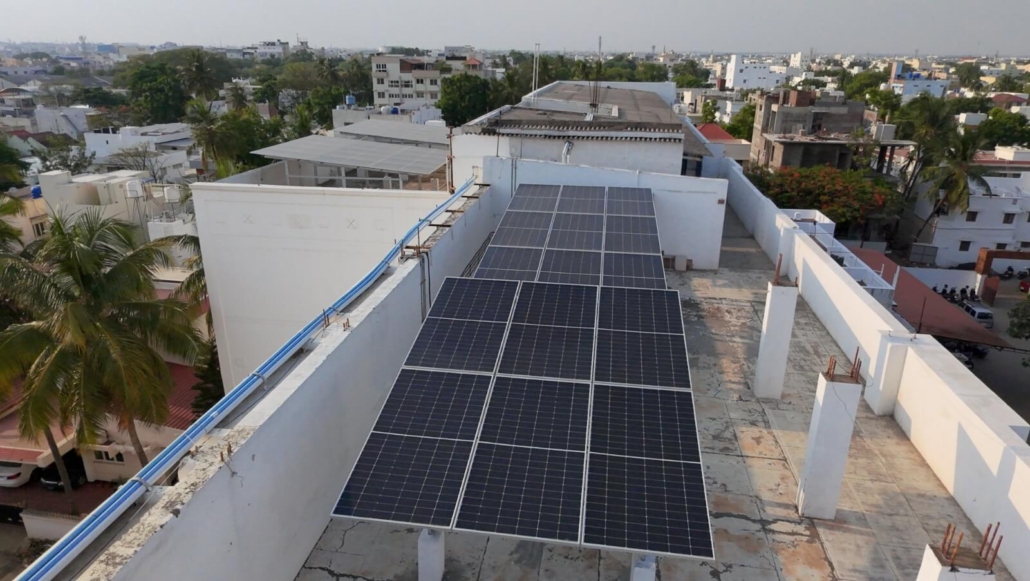

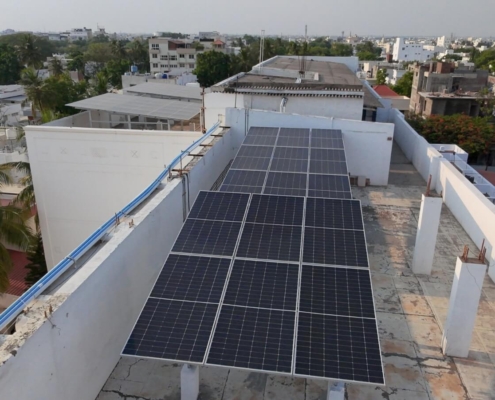

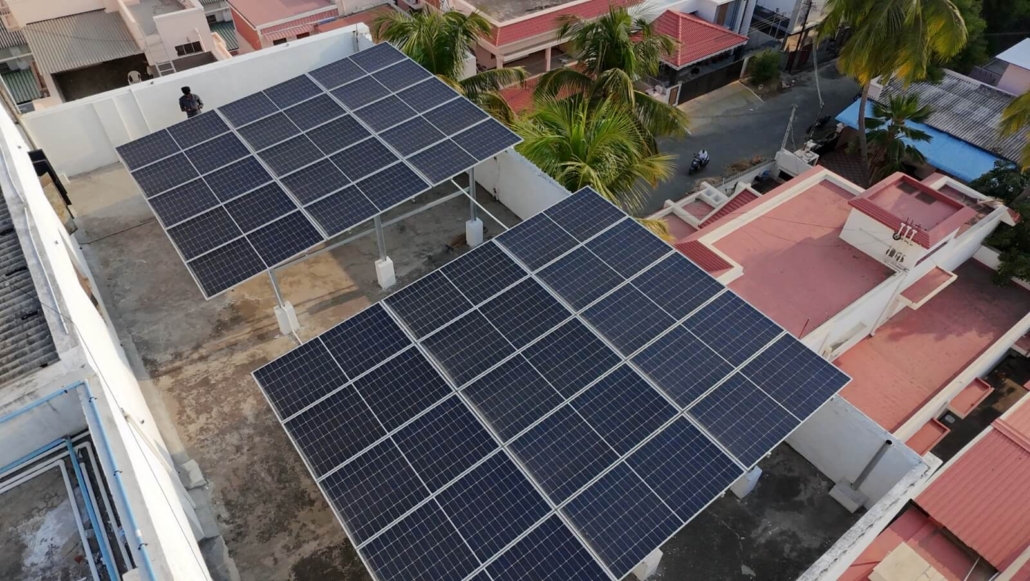

- 25Kw Kids Matriculations School – Tiruppur

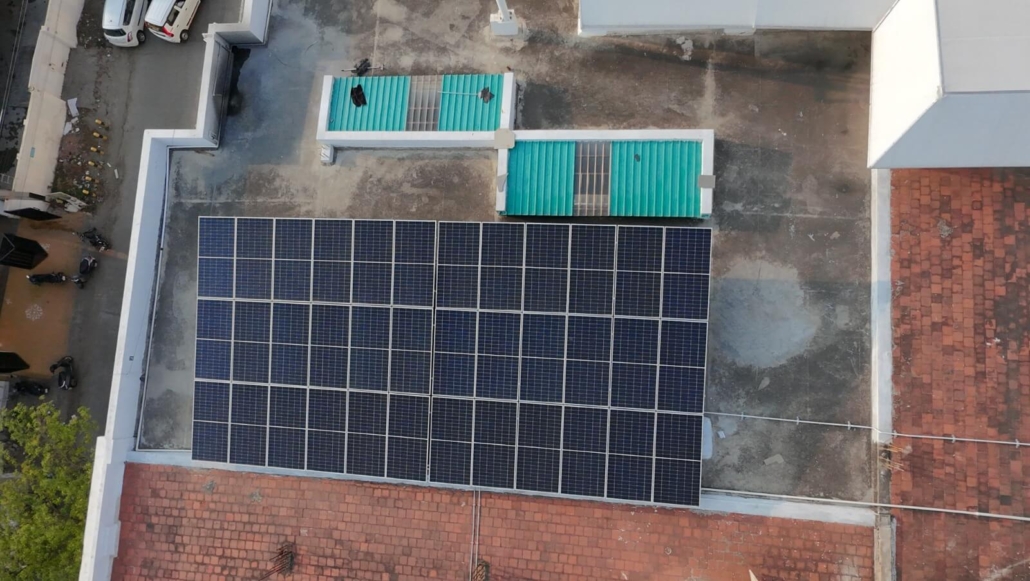

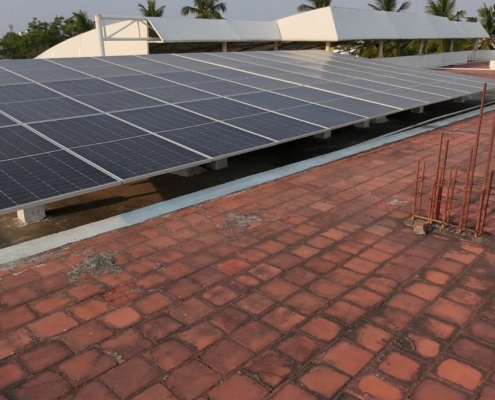

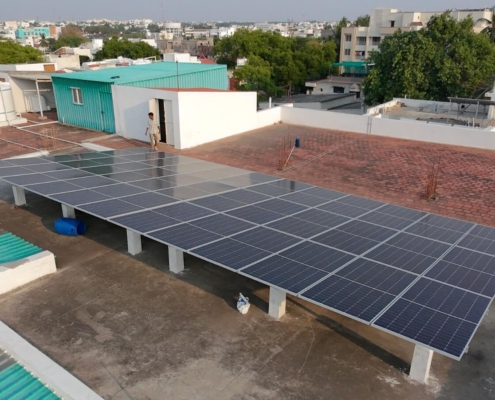

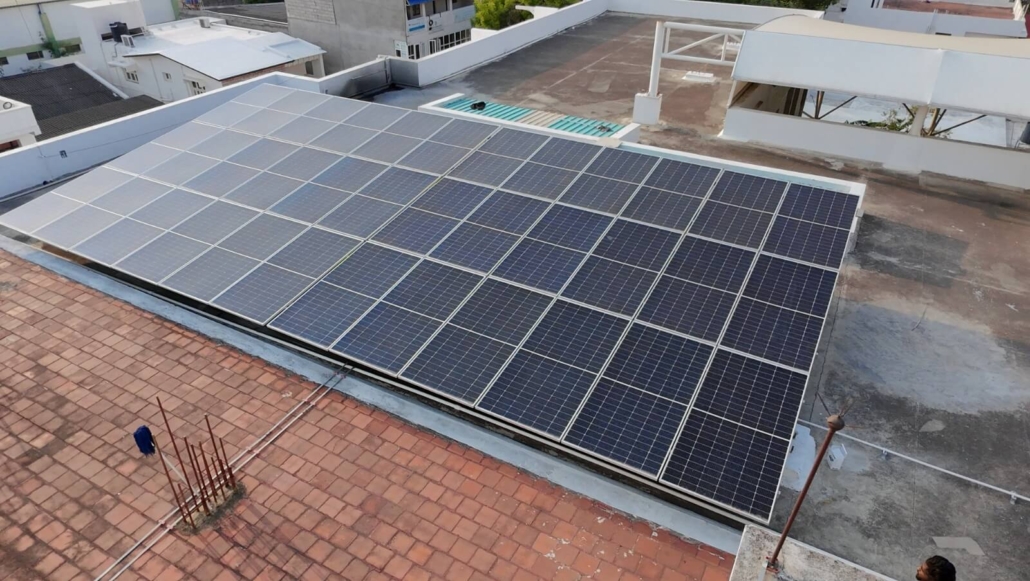

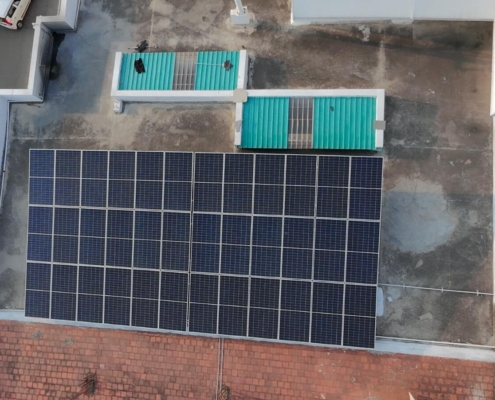

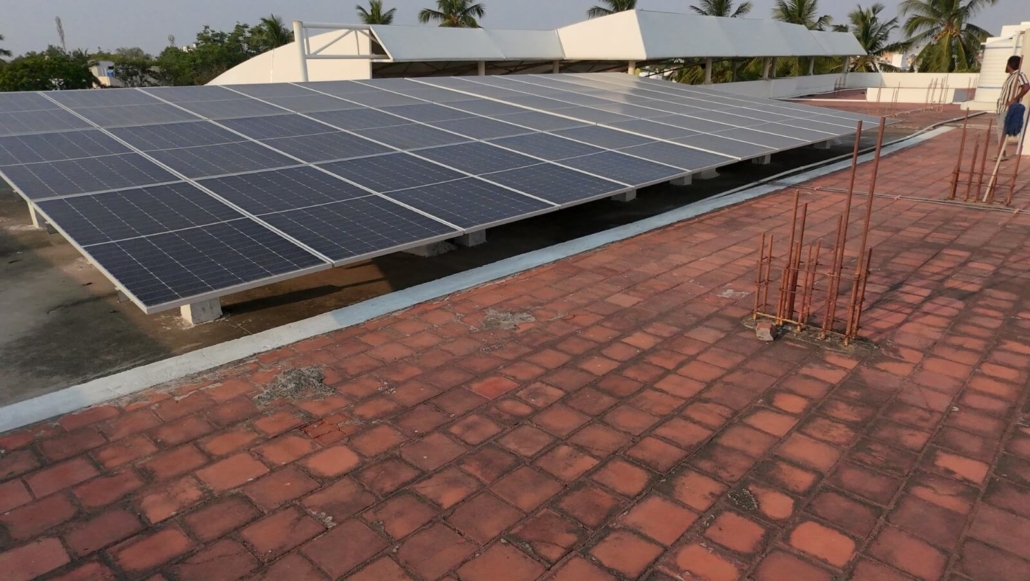

- 20kw kids International school – Tiruppur
- 50kw Aqua purifier Pvt Ltd – Thanjavur
- 50kw Plansee – Mysore
- 169.95kw The Chennai silks – Coimbatore
- 271.4kw Satta knowledge Point – Bangalore
- 450kw premier Plasmotec – Karnataka
- 399.73kw Golden Granite – Chamarajangara , Mysore
- 80kw Sri Nachammal Vidyavani School CBSE – Avinashi
- 700kw Rainbow spinning Mills – Thiruchankodu , Erode
- 568 2 KWp Capacity – T.P Mill – Rajapalayam
- 460 KWp Capacity – NPP – Rajapalayam
- 740 10Wp Capacity – Compact Mills – Dindugul
- 11.9 KWp Capacity – JT Fabrics – Madurai
- 8 KWp Capacity – Ramakrishna Residency – Dindugul
- 5 KWp Capacity – Nagappan Residency – Dindugul

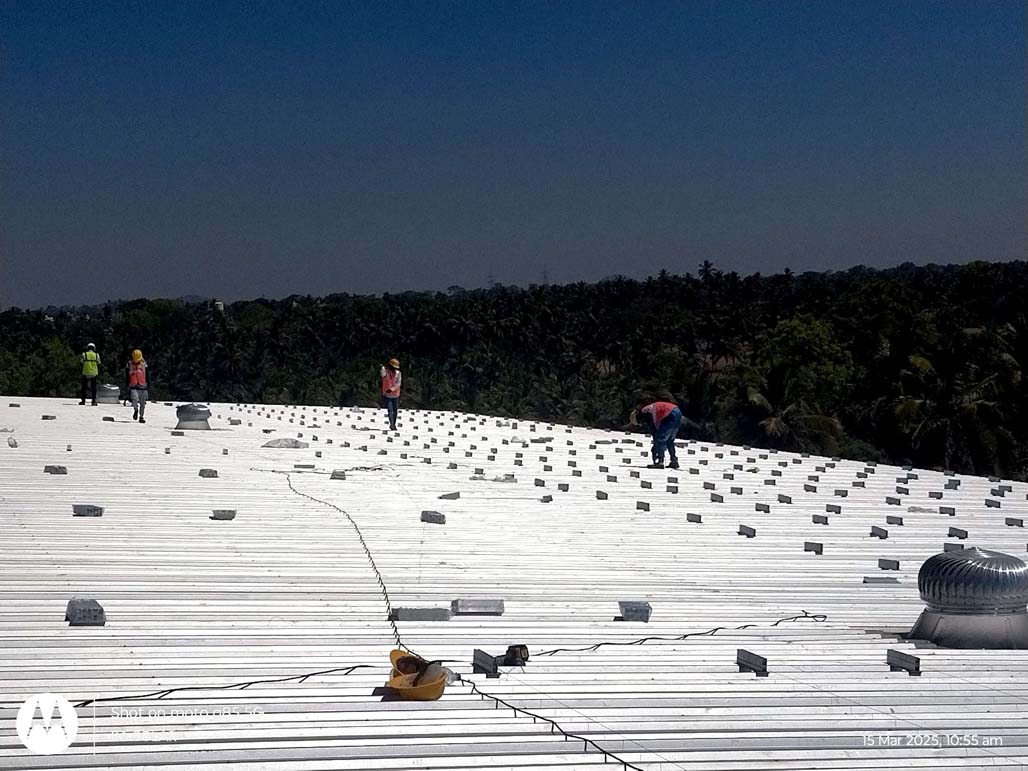

- 40 KWp roof top solar project – Nachammal School – Avinachi
- 100 KWp roof top solar project – GV Textails – Dindigul
In Pondichery places.
- 343.44 KWp Capacity – Berger Paints – Pondichery.
In Karnataka places.
- 408 KWp Capacity – Arvind Lifestyle, Hoskote Project.
- 227 KWp Capacity – Mallur, Karnataka.
RA solar carrier solar project with Bernsol Pvt Ltd.
- 1658 KWp Capacity – Ambika Cotton Mill.
- 580 KWp Capacity – Ambika Cotton Mill.

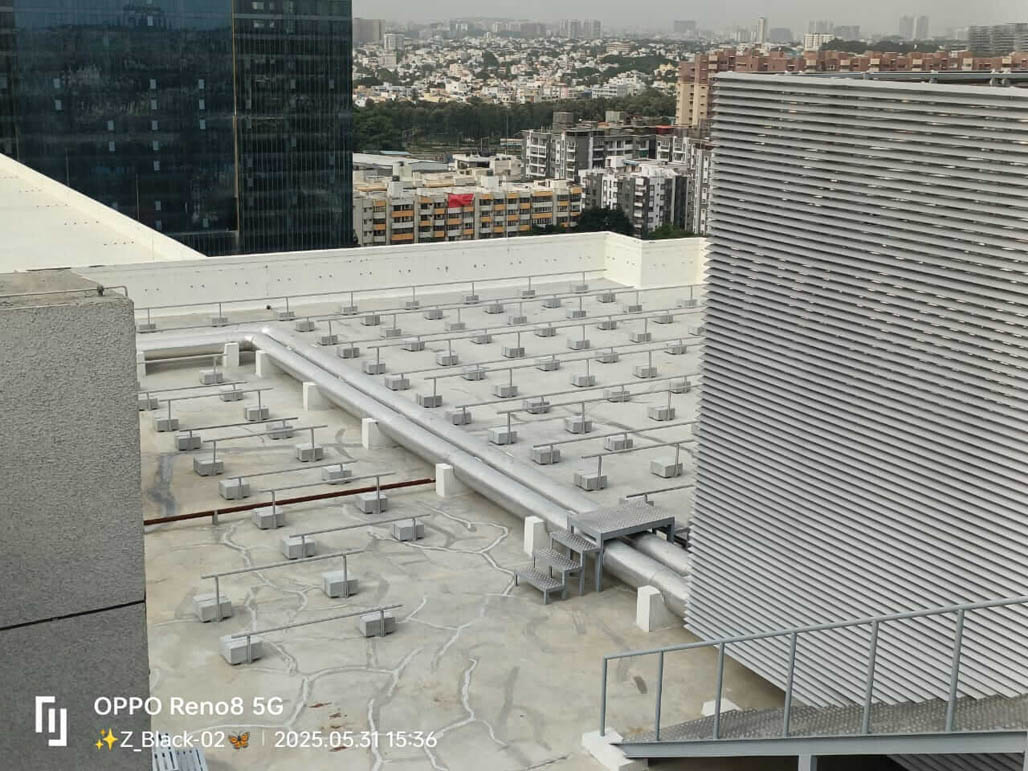

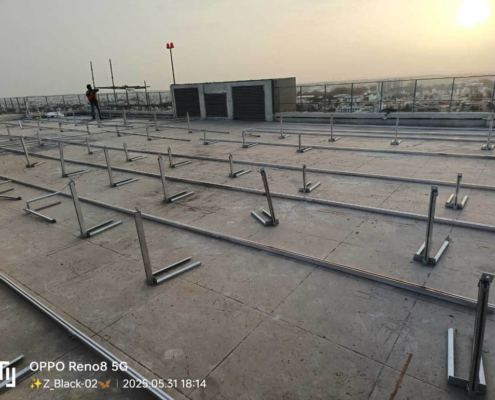

PPT – SCM Tekkalur Project (07/01/2025)

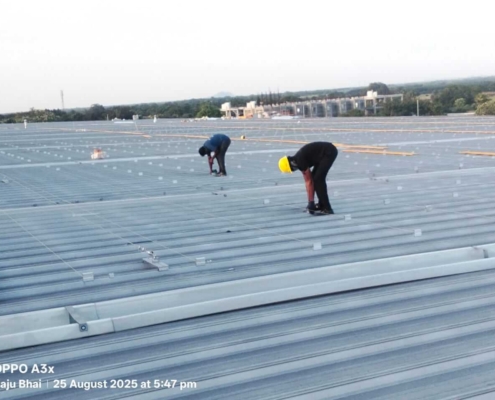

Daily progress at SCM Tekkalur includes walkway fixing and water line work carried out by a team of 7+1 manpower on 07/01/2025.

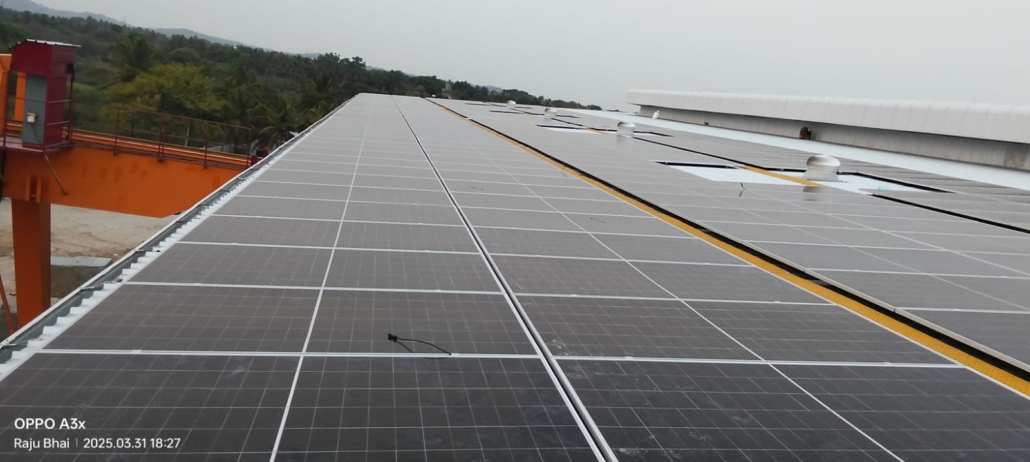

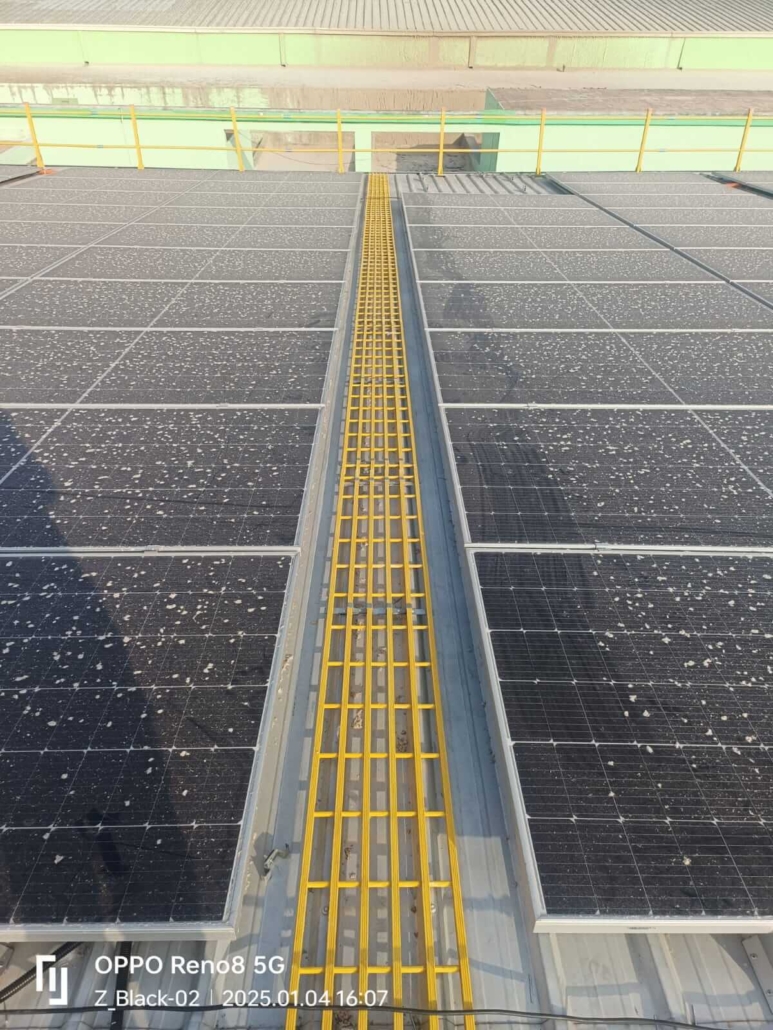

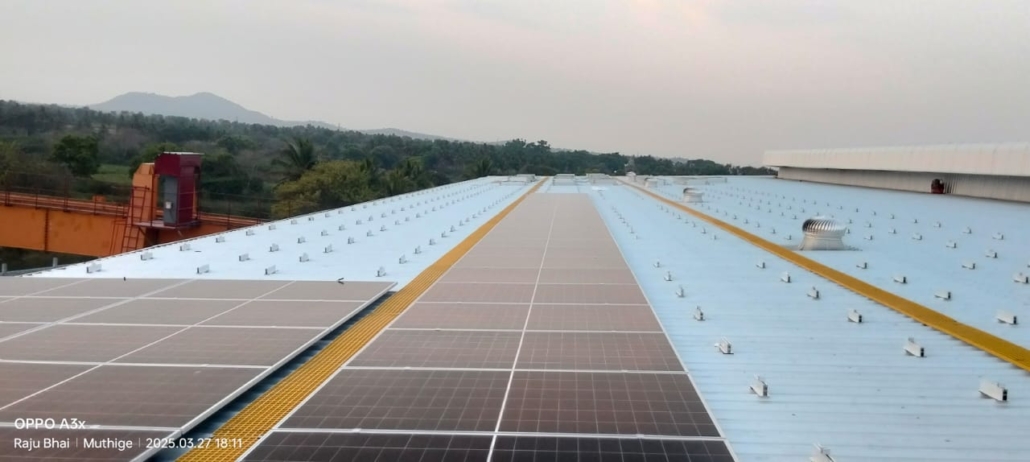

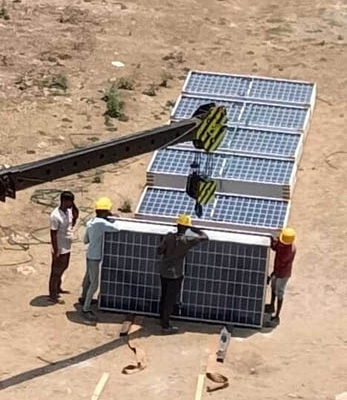

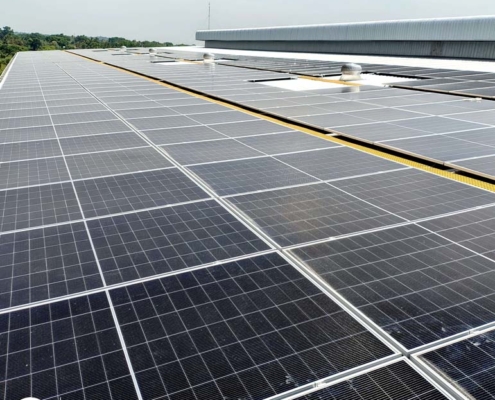

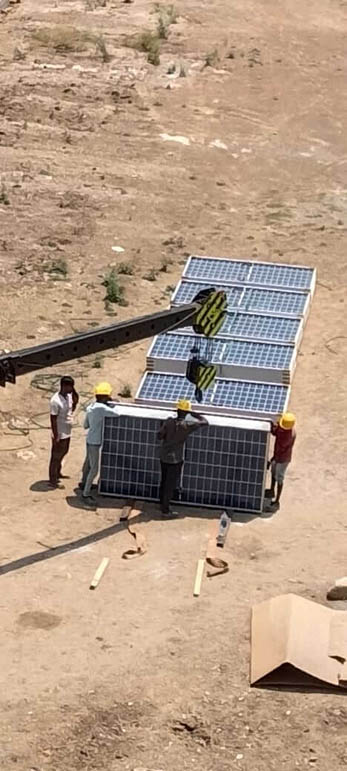

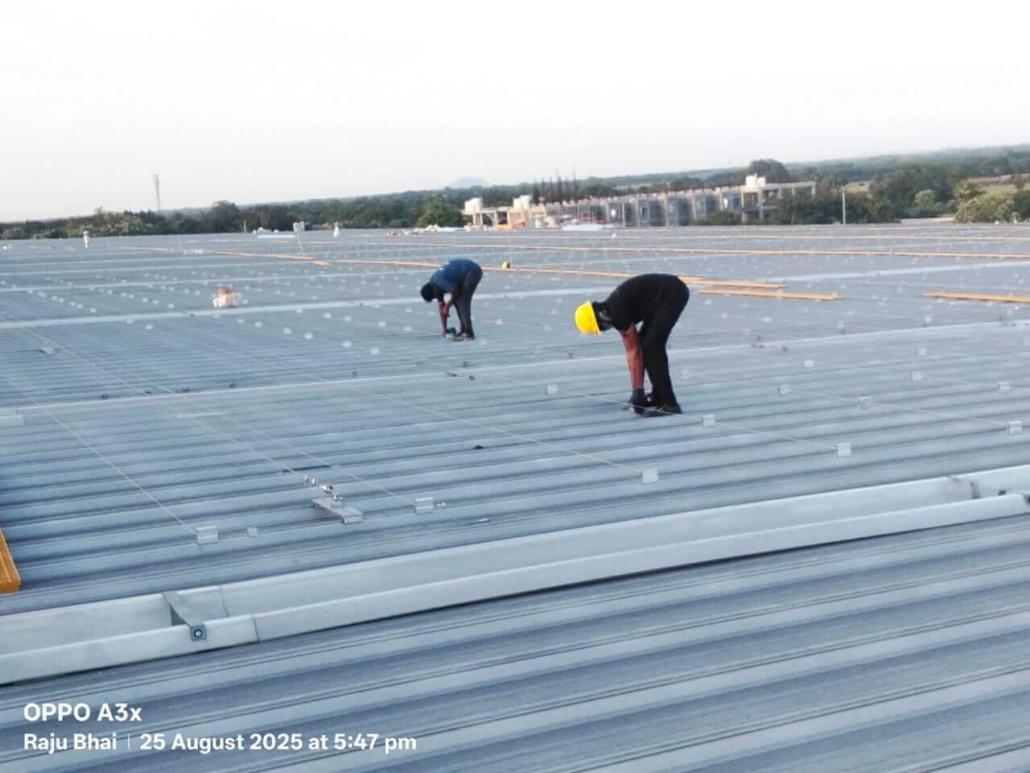

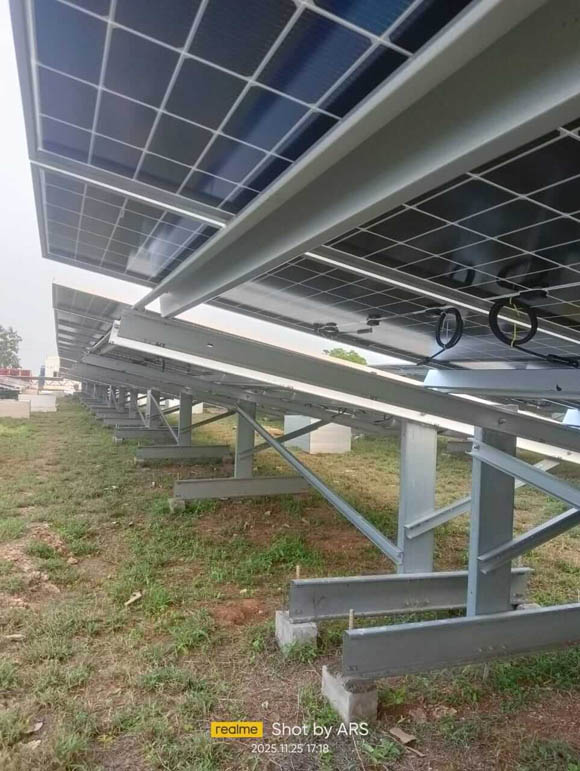

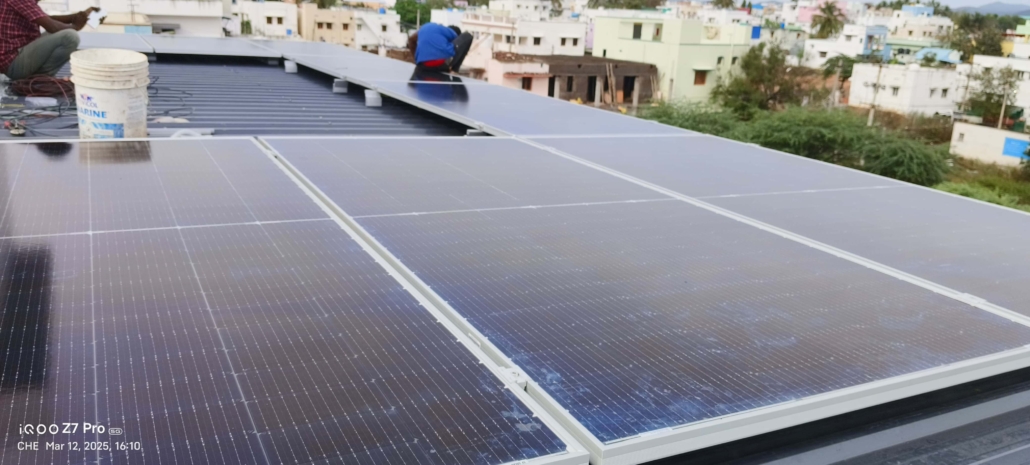

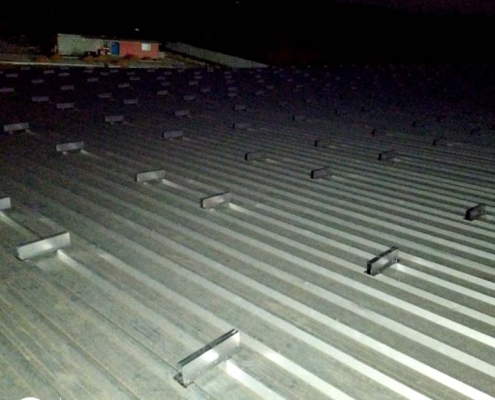

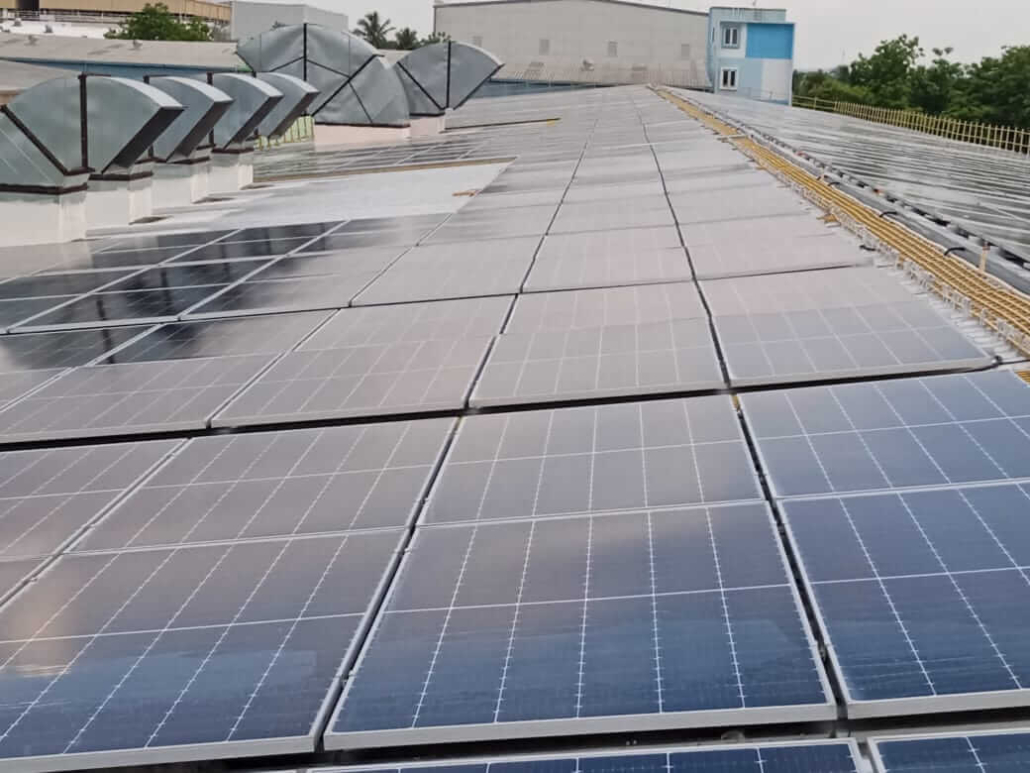

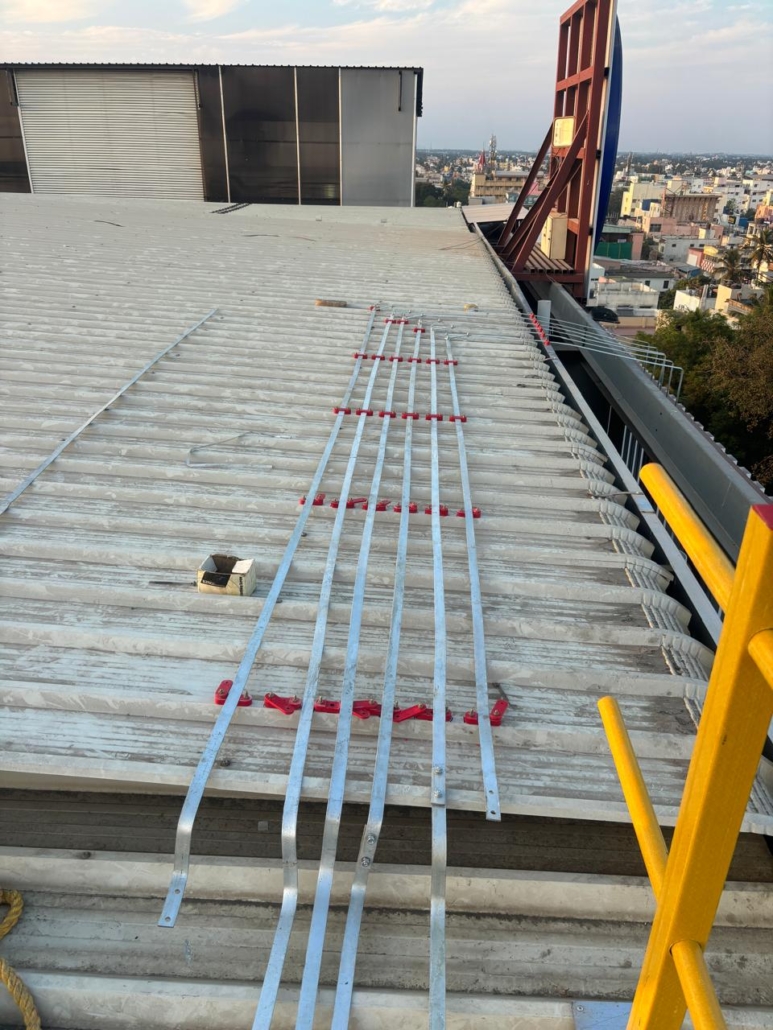

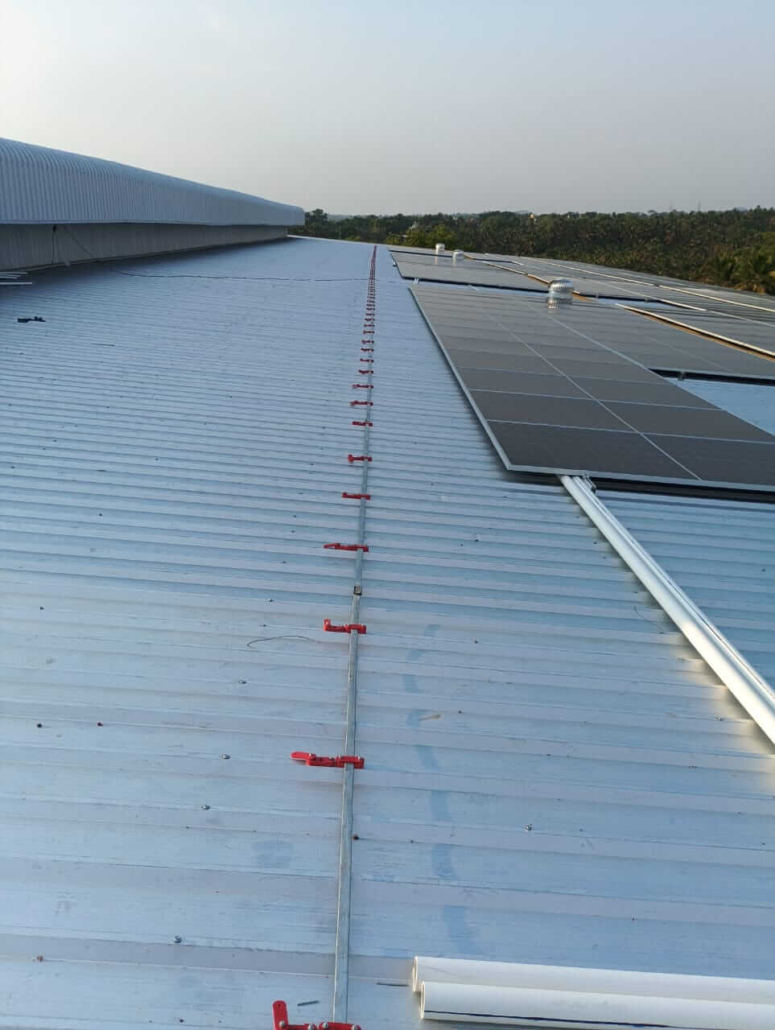

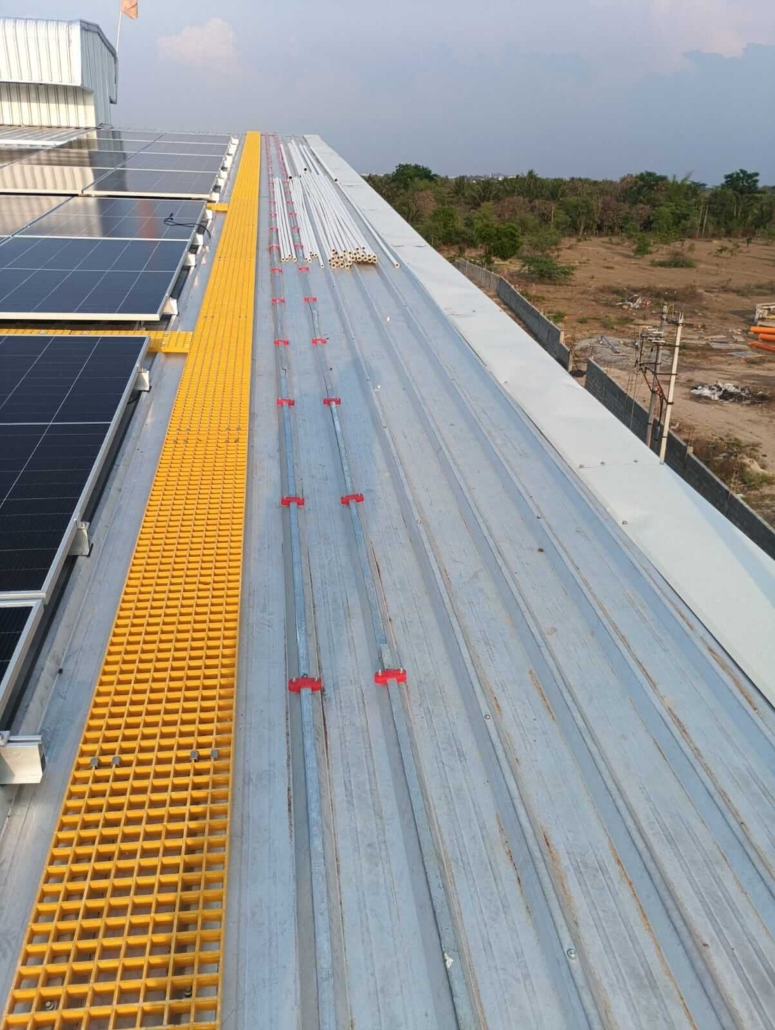

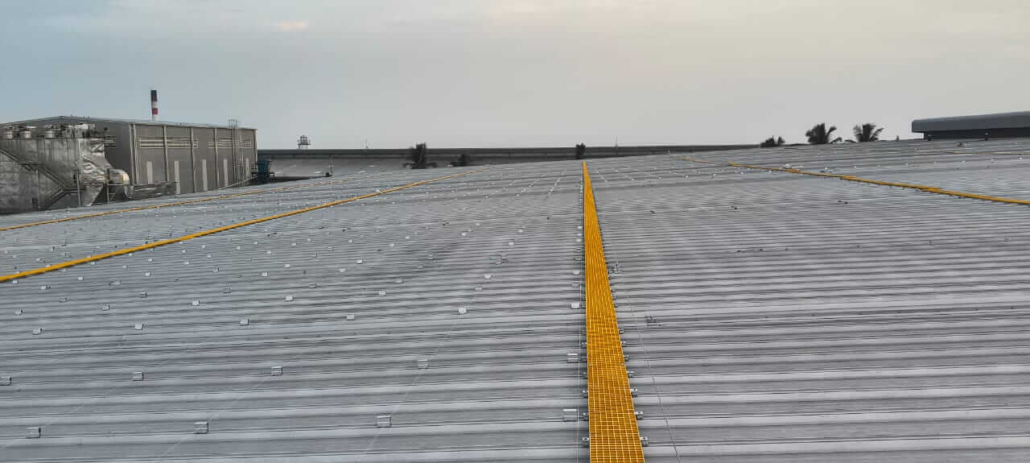

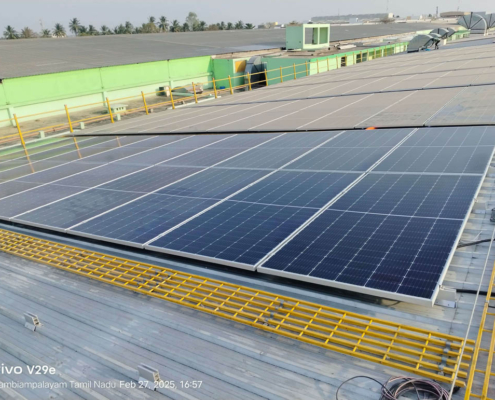

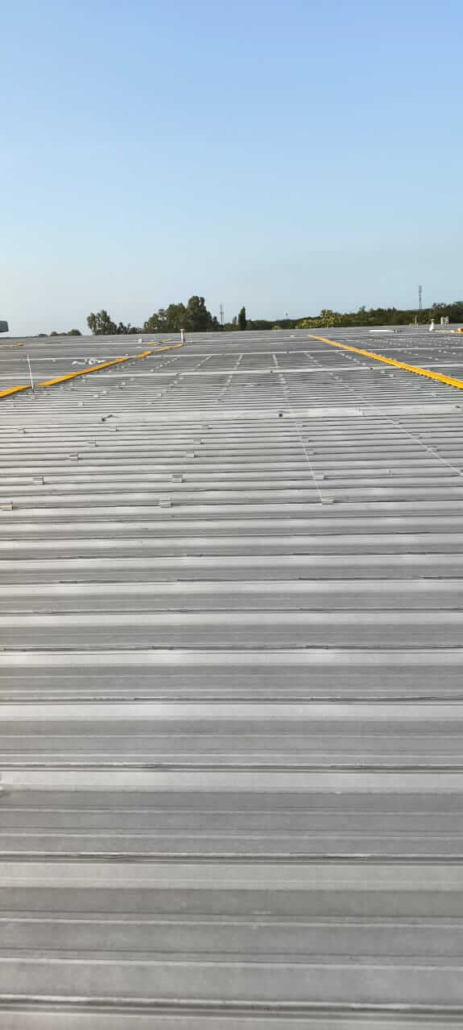

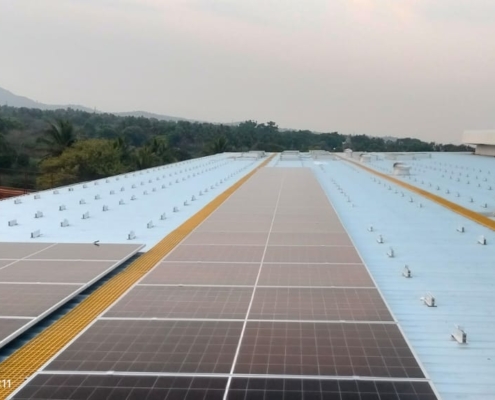

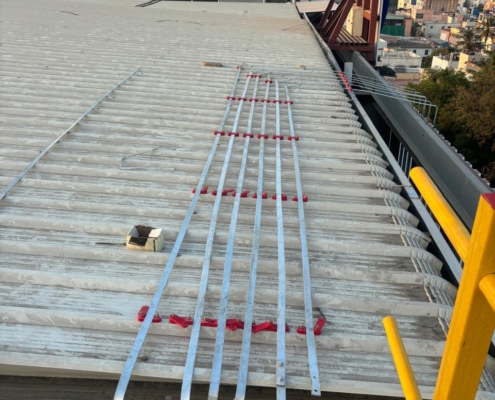

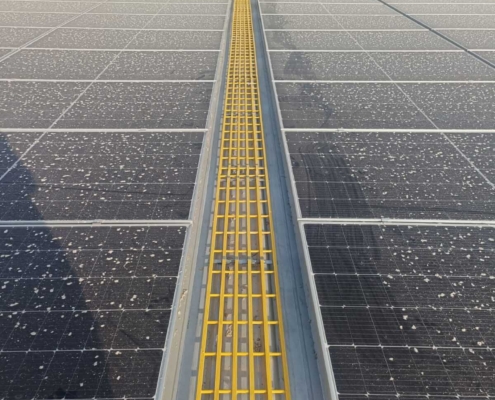

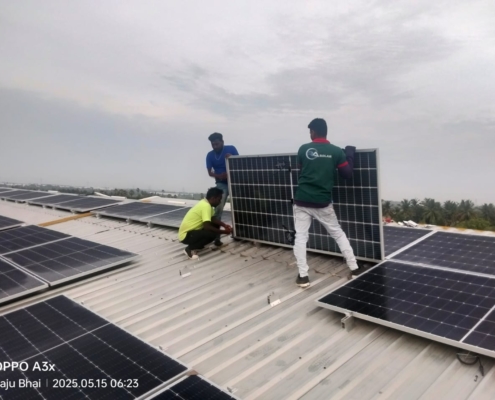

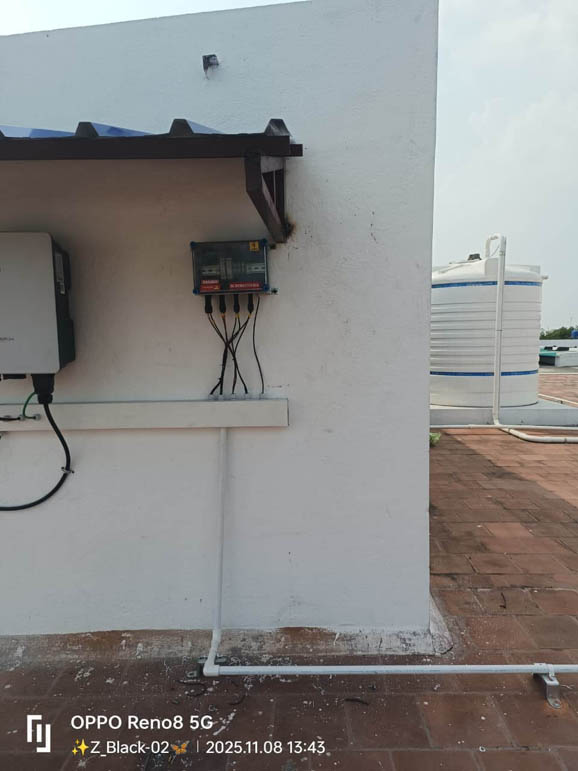

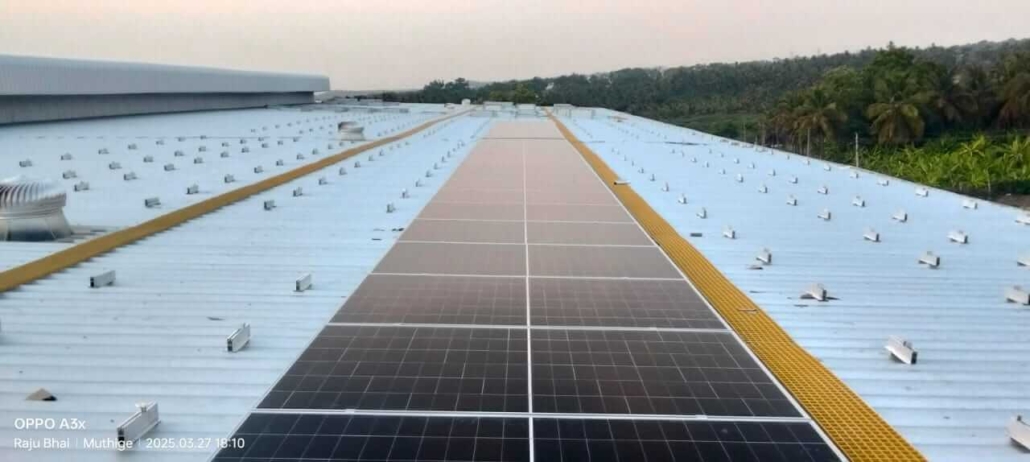

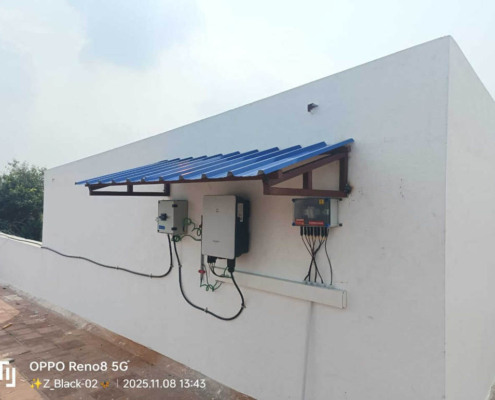

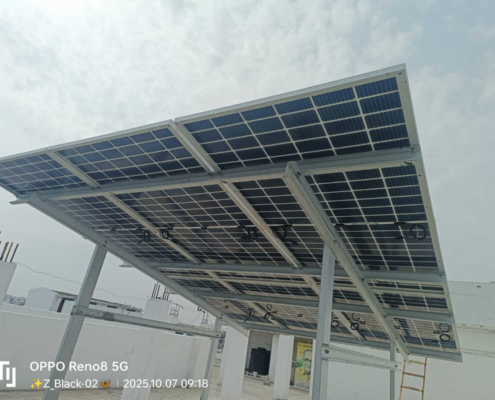

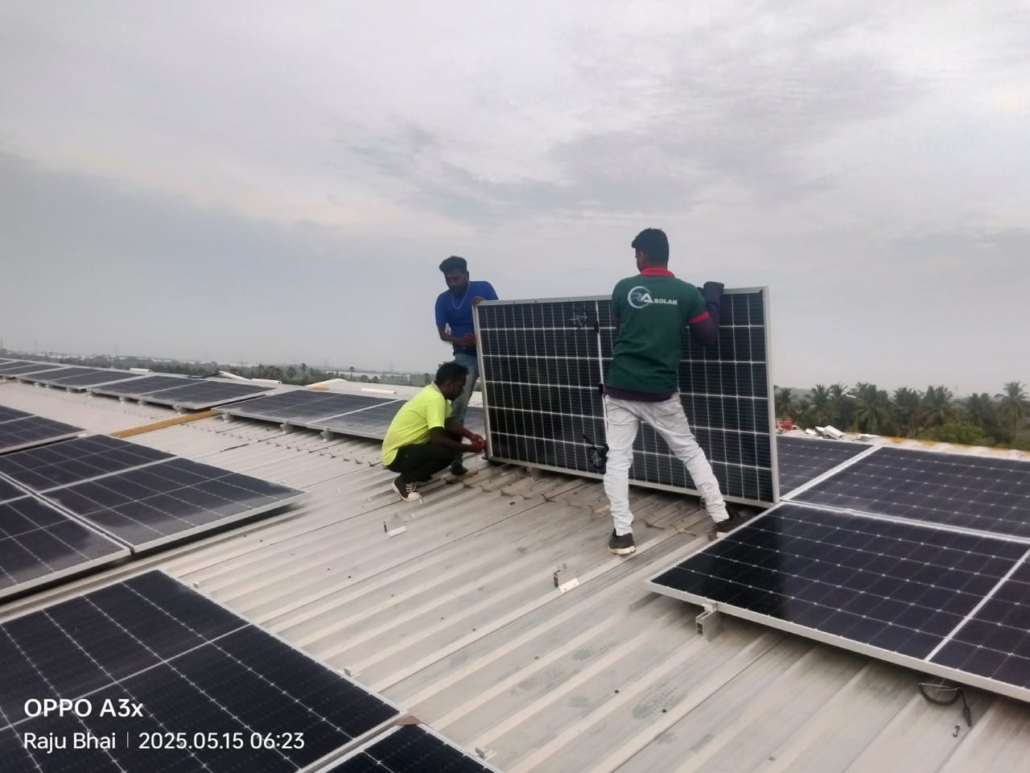

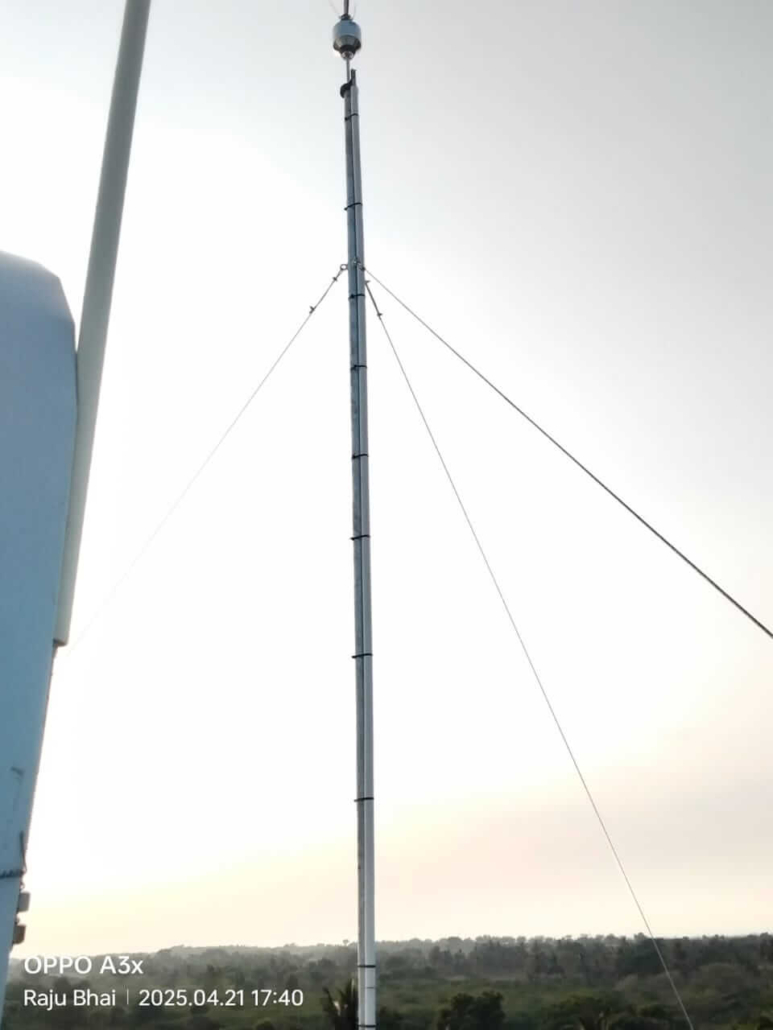

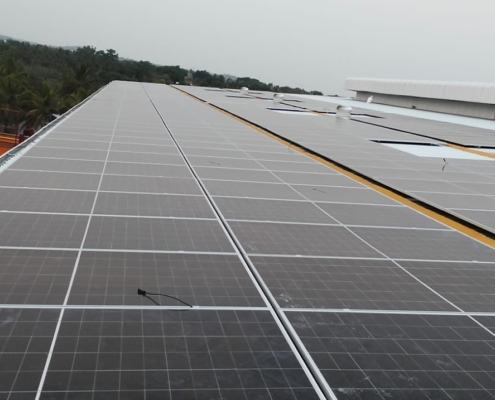

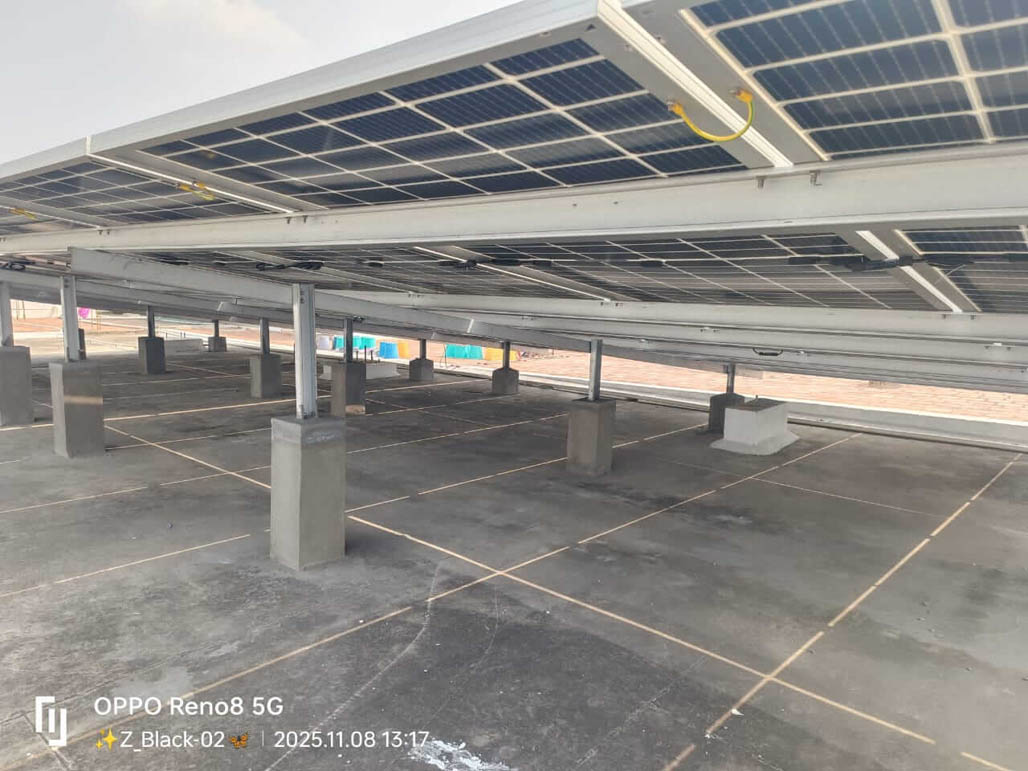

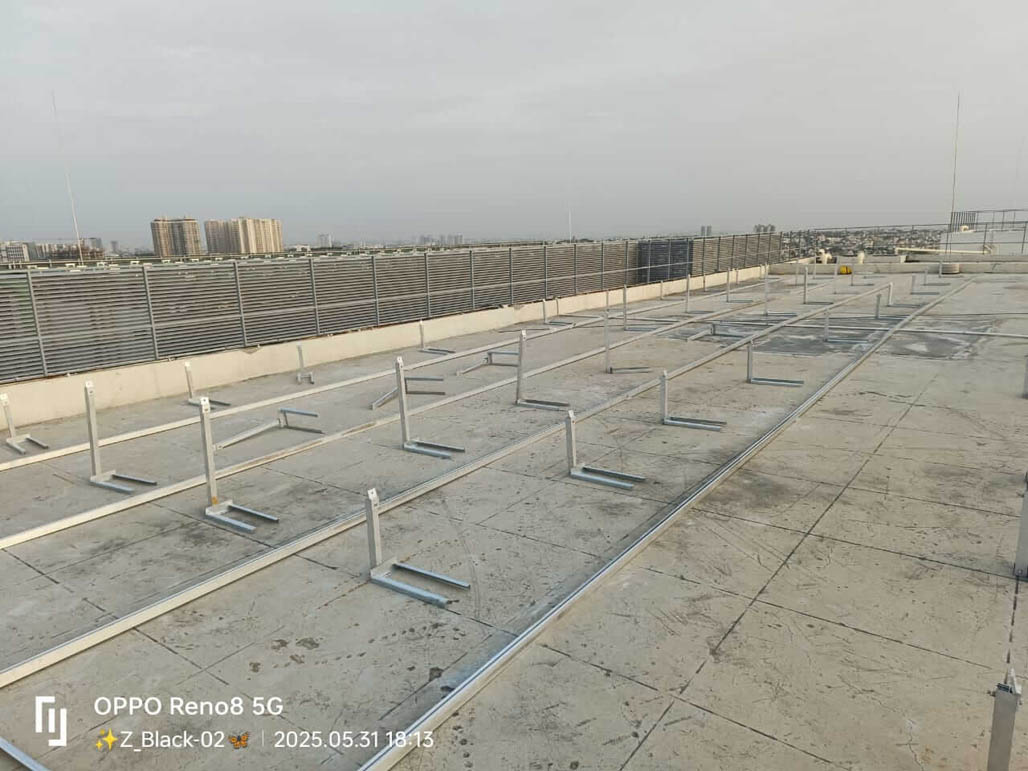

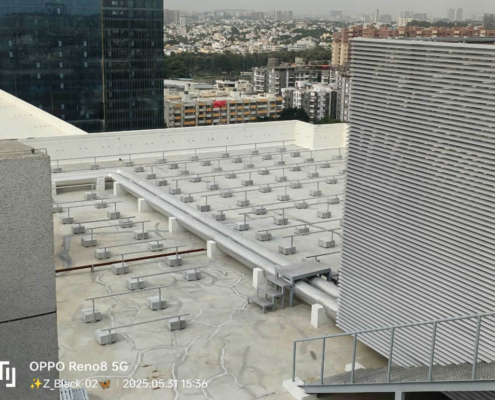

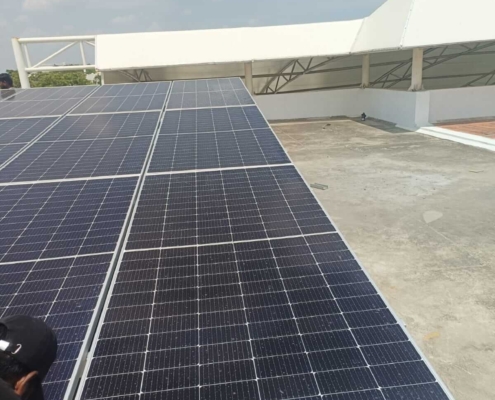

Module Mounting Work

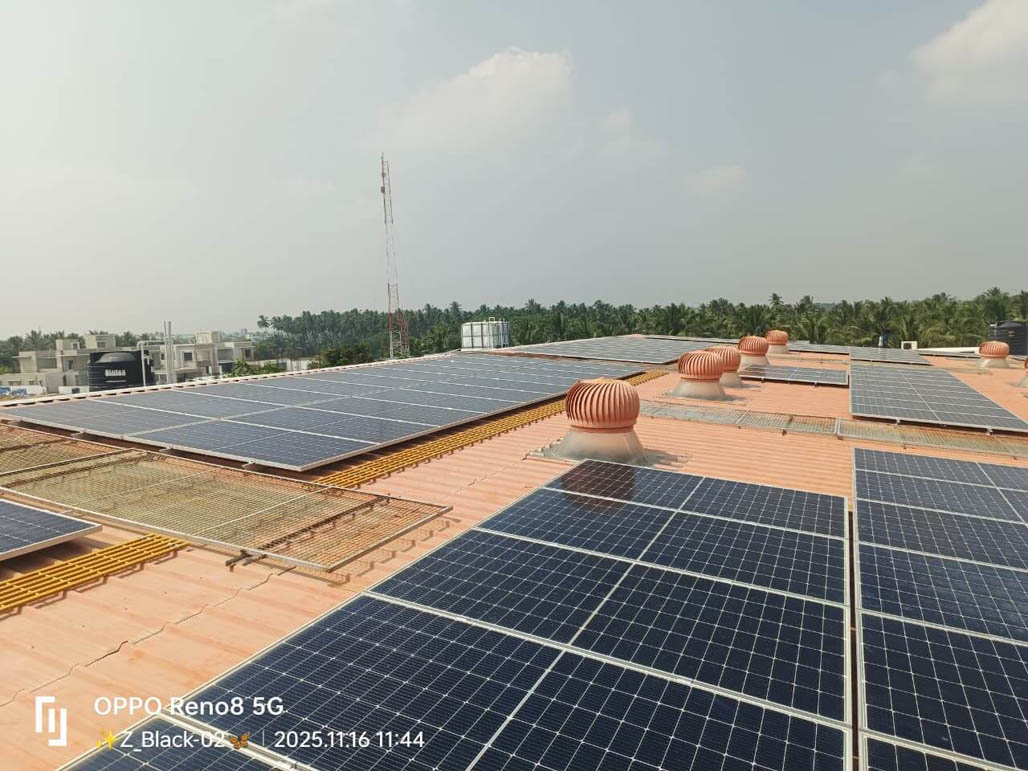

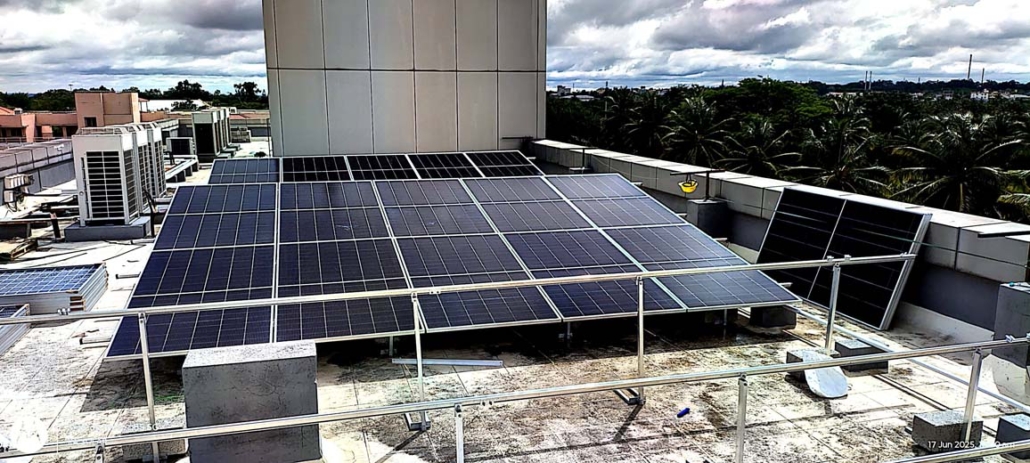

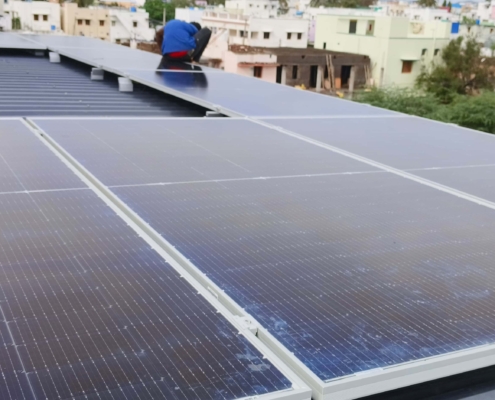

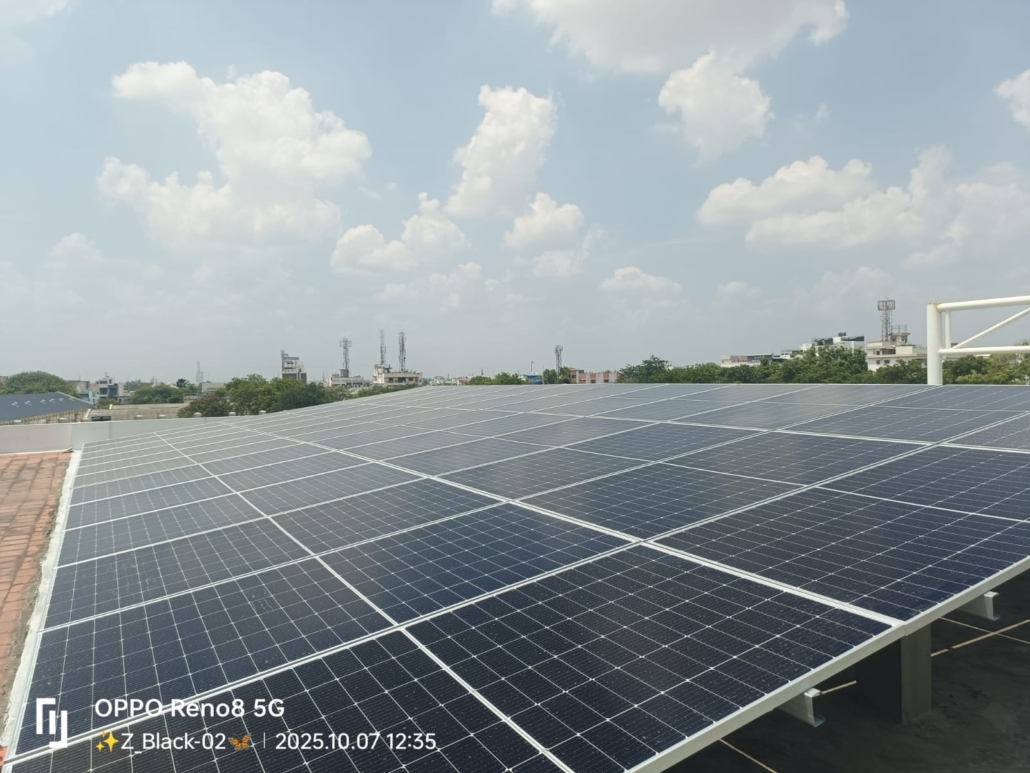

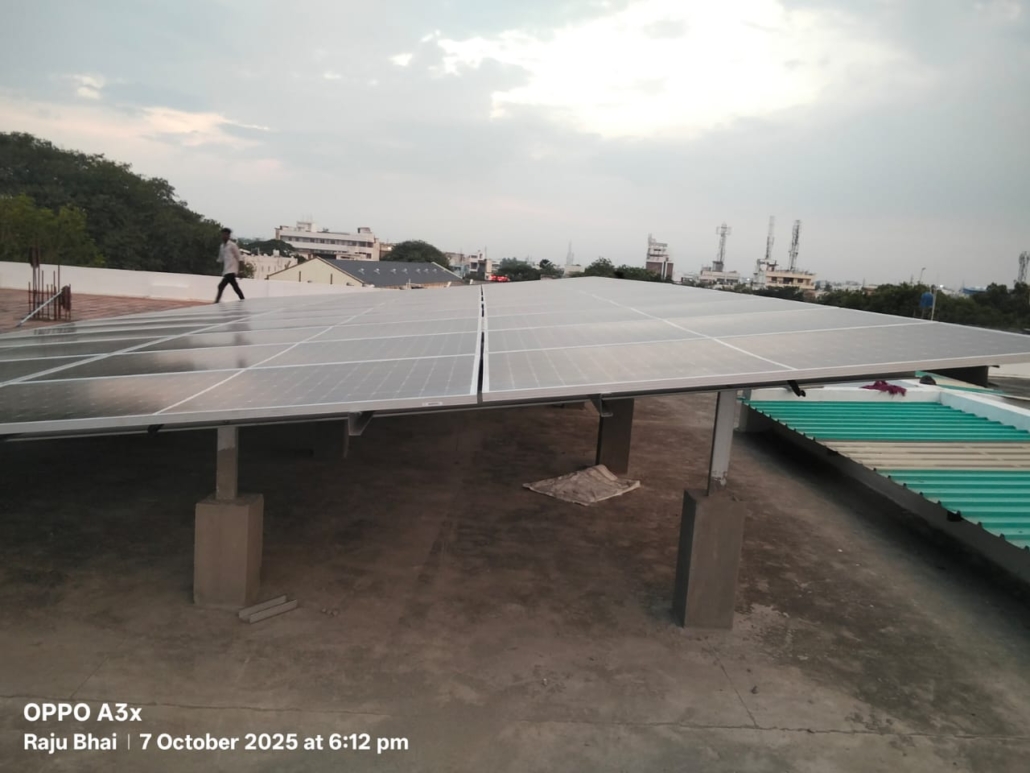

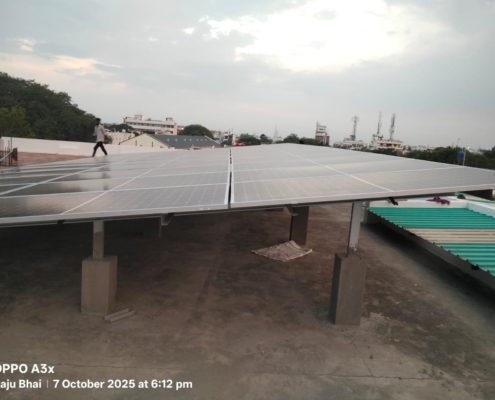

International School Project

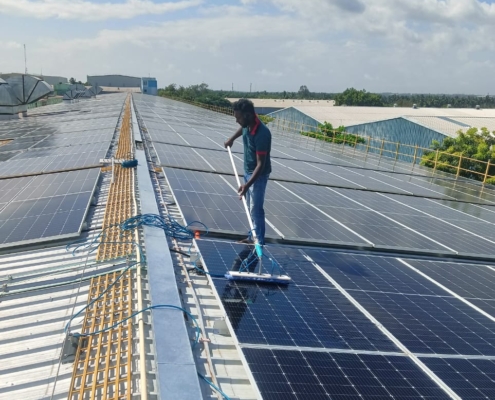

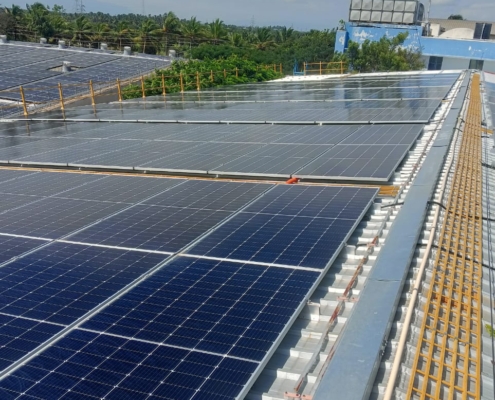

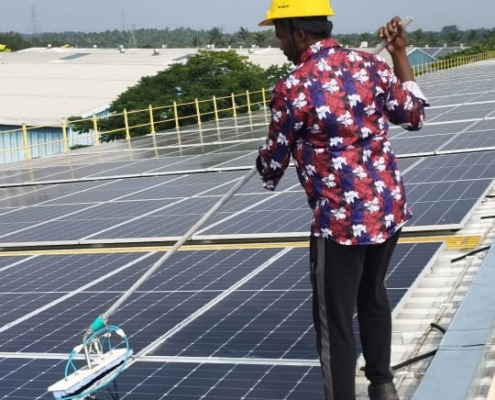

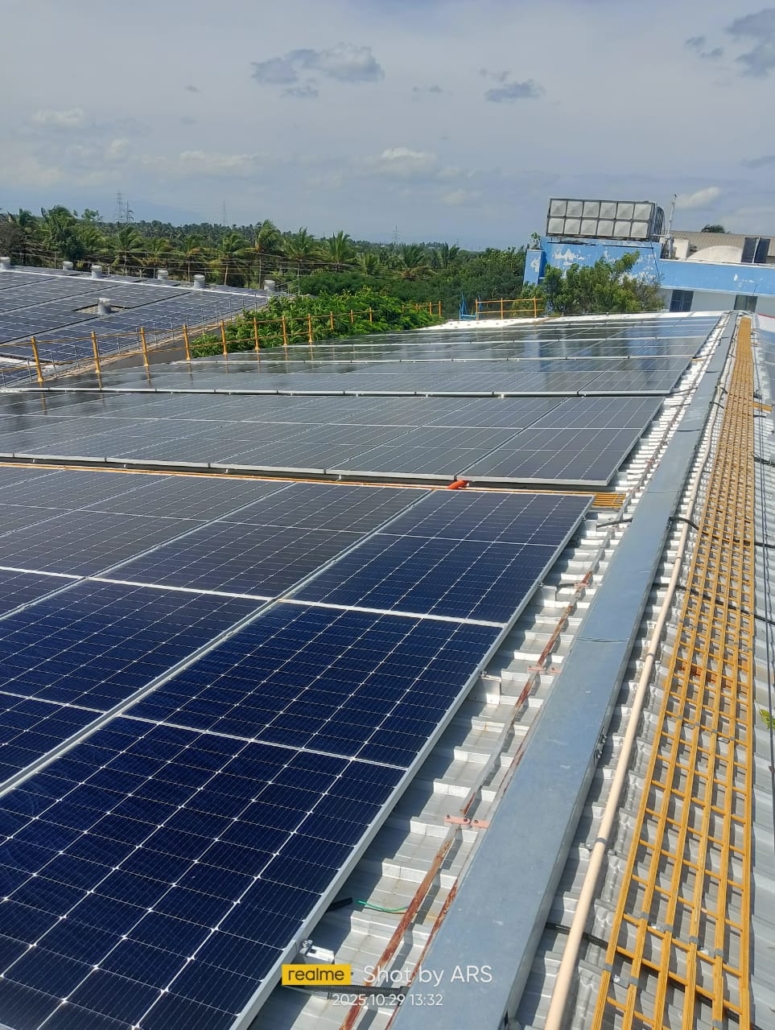

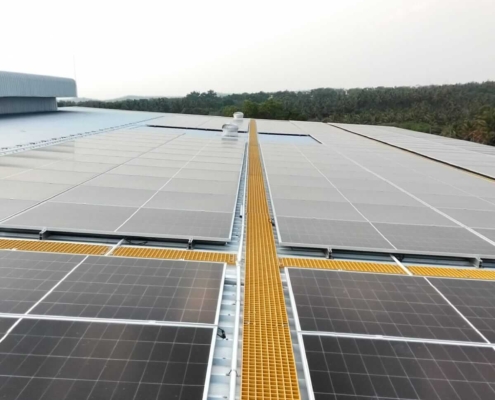

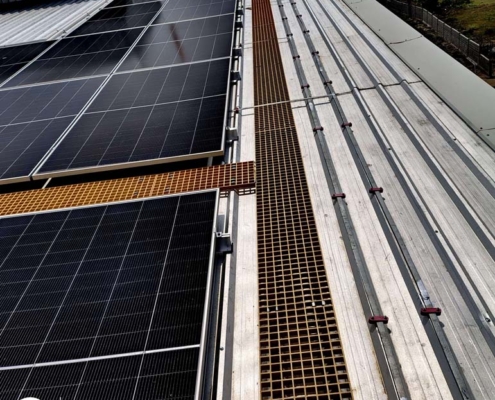

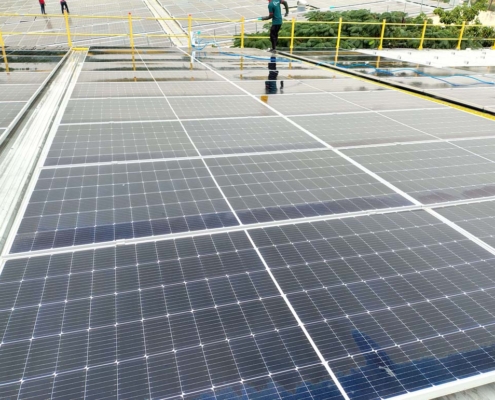

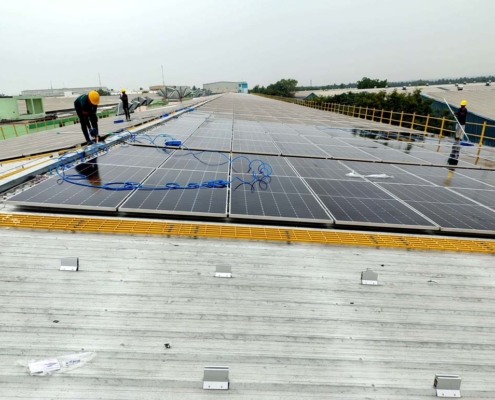

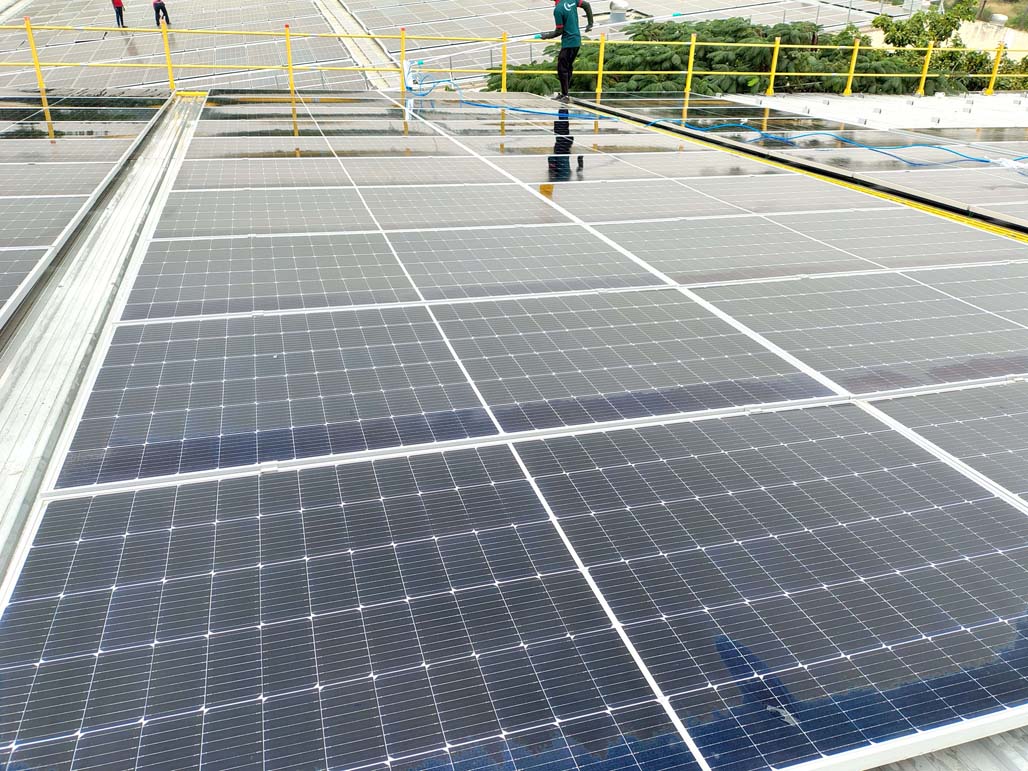

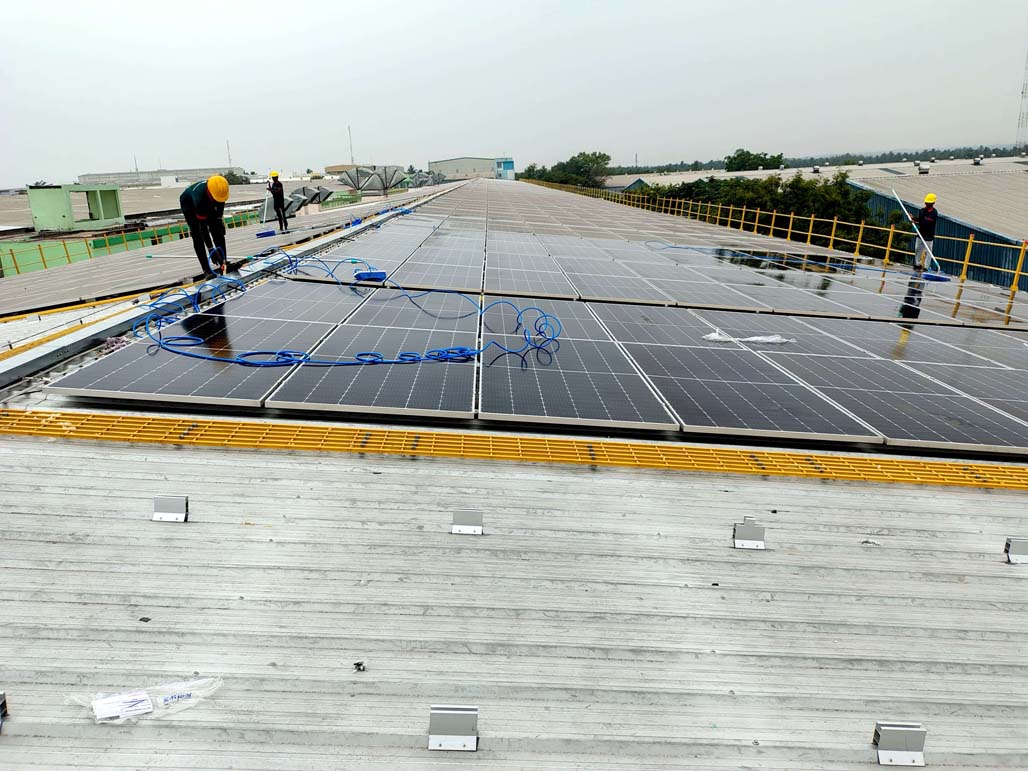

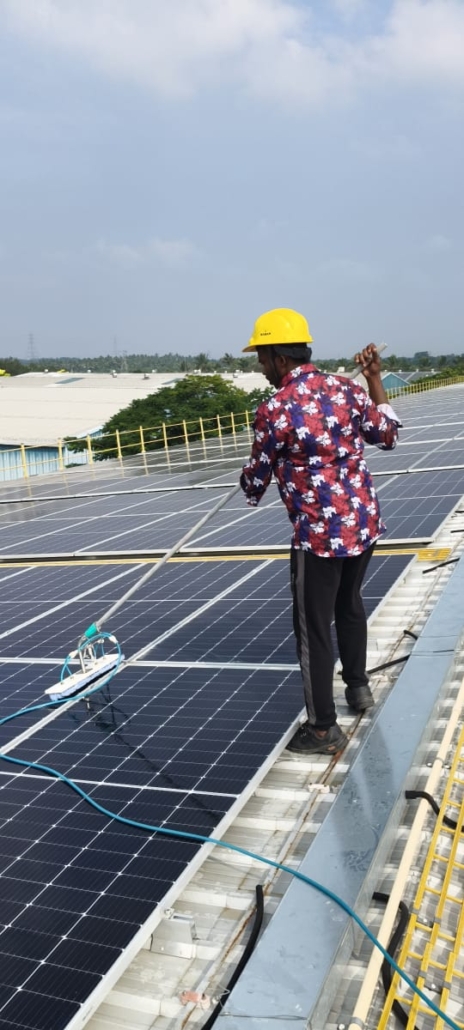

SCM MIL Panel Cleaning Work

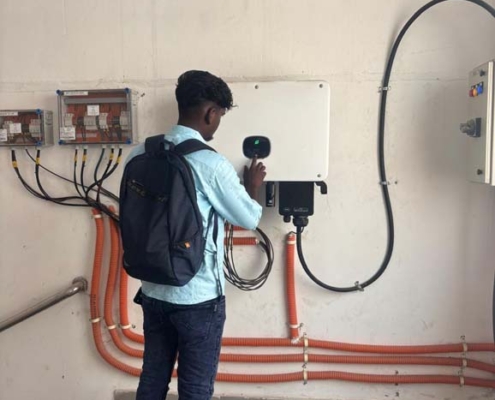

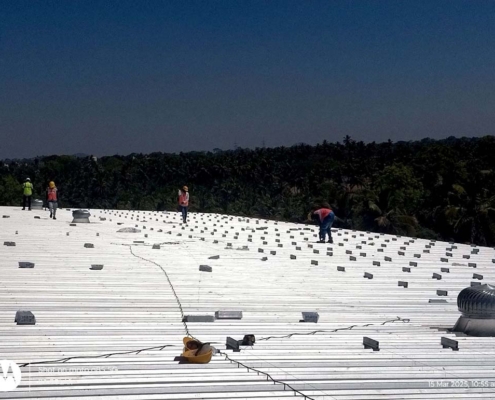

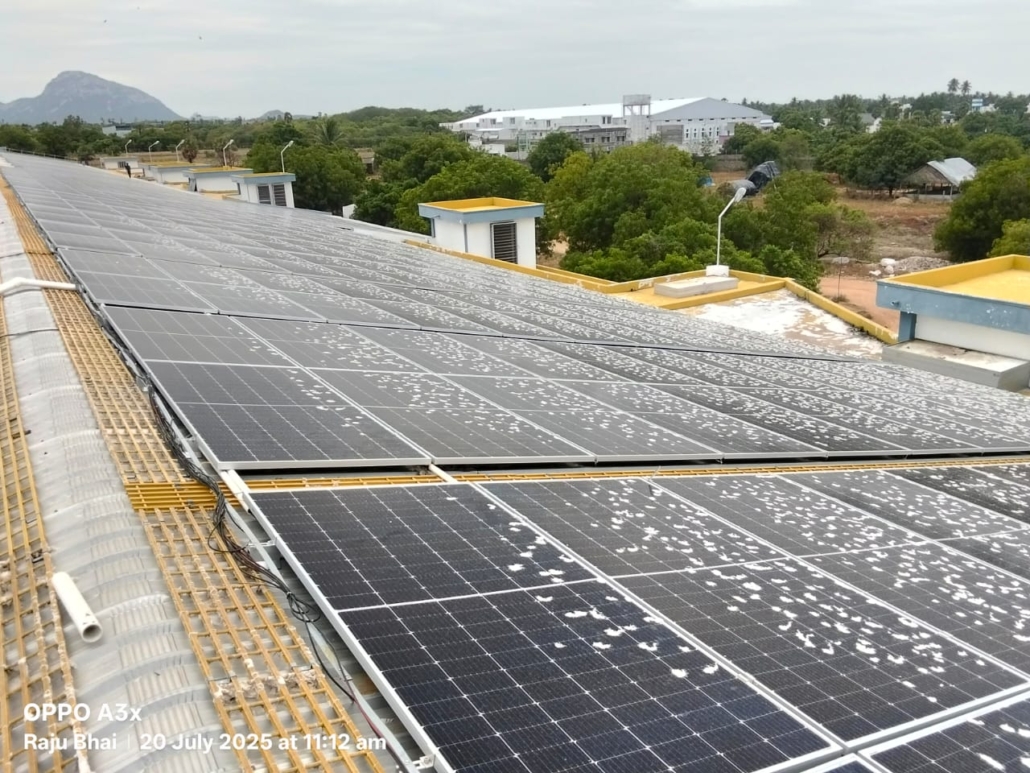

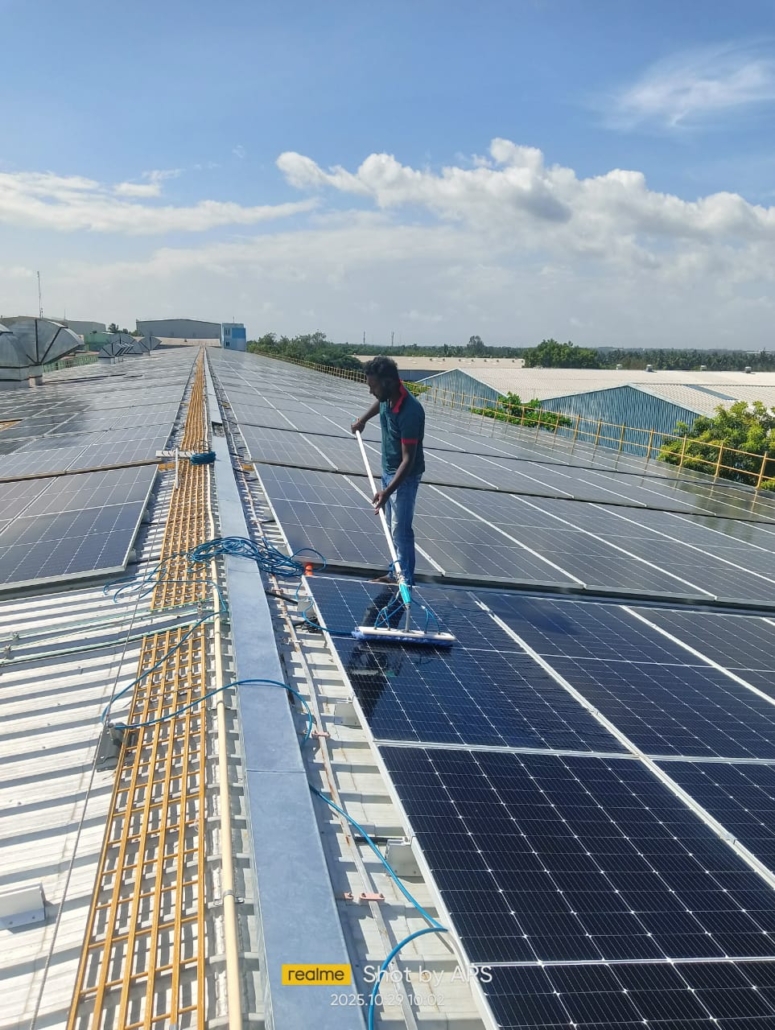

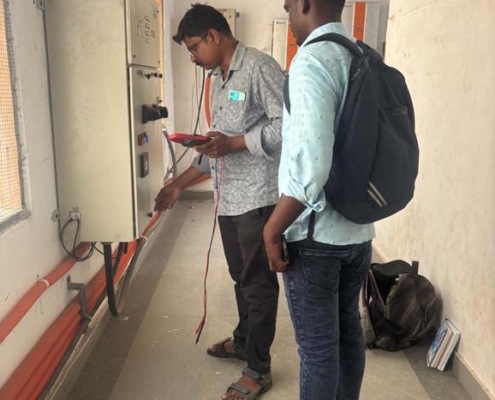

SCM MIL – Solar Panel Cleaning Work Status Update

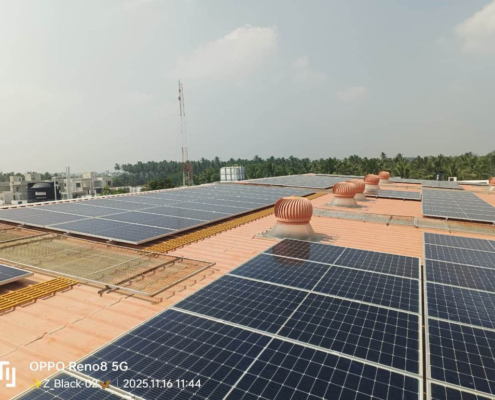

- Total panels cleaned today: 316

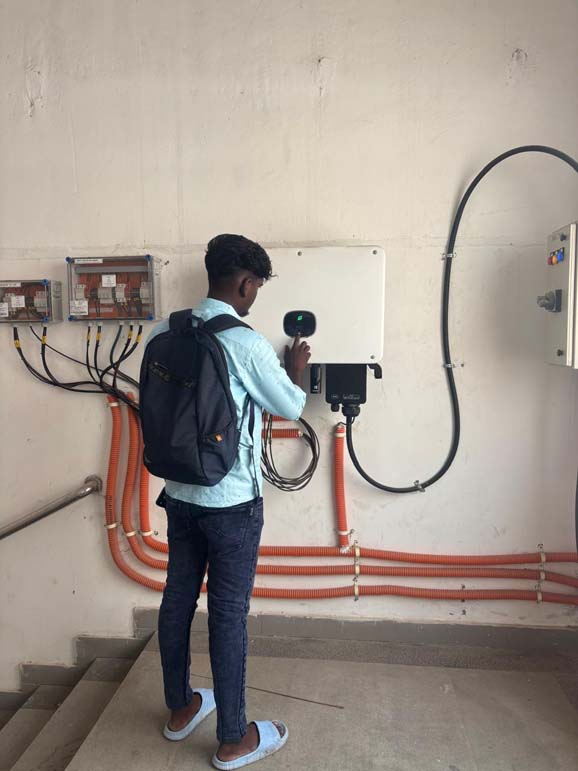

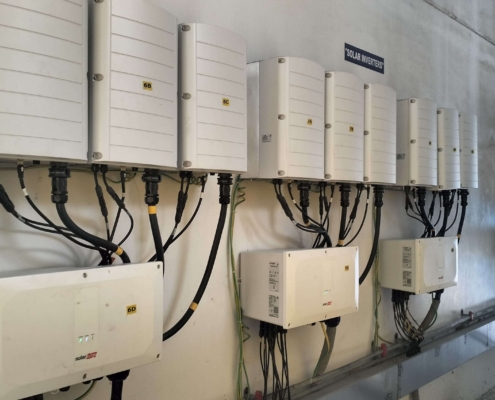

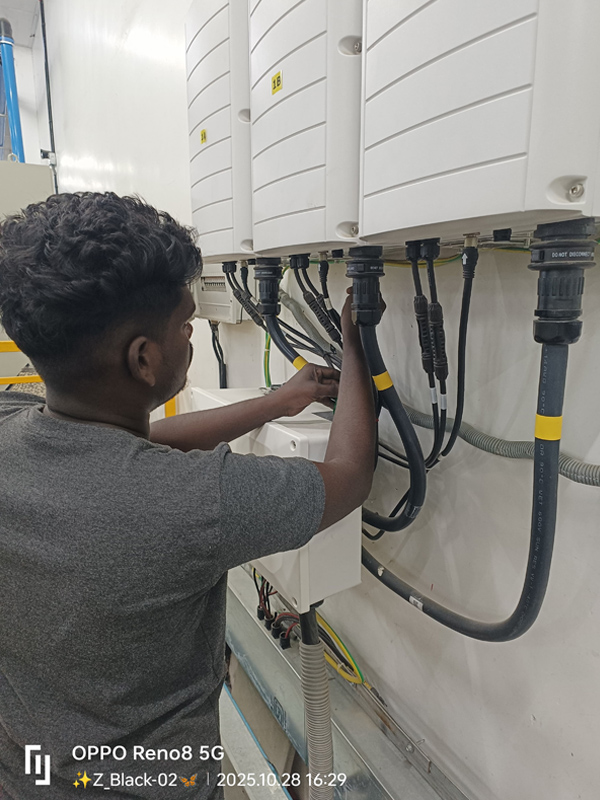

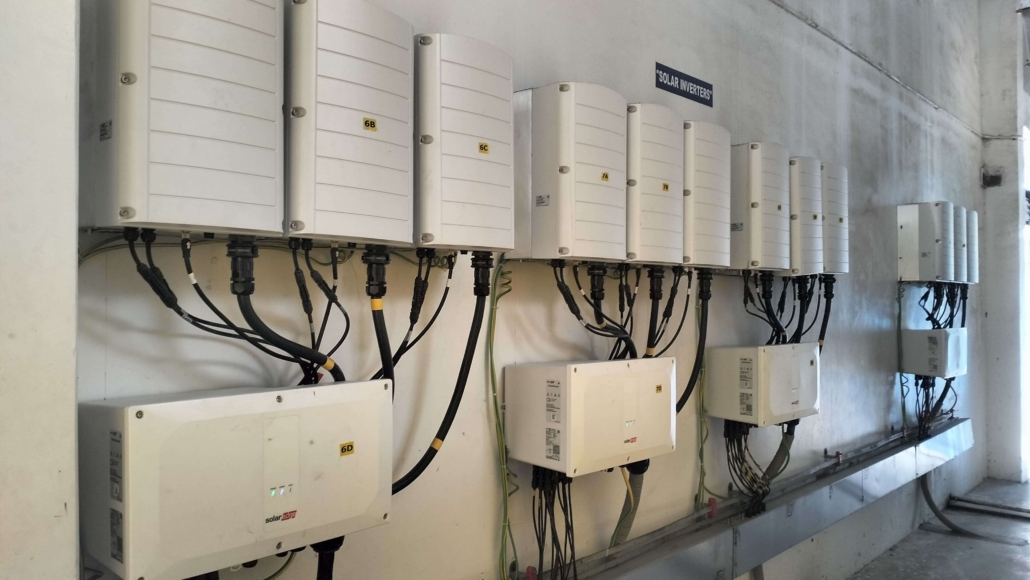

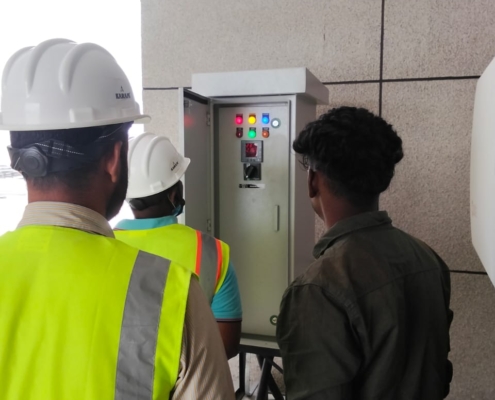

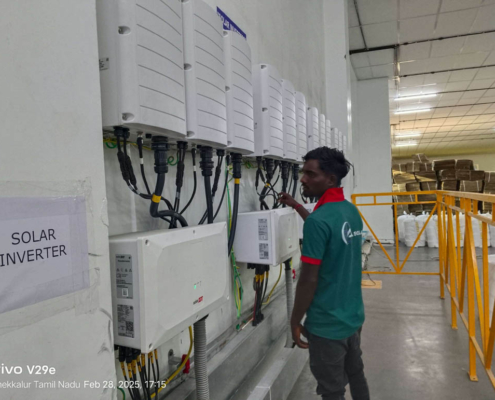

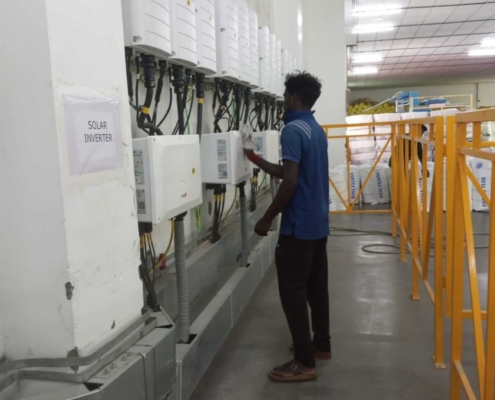

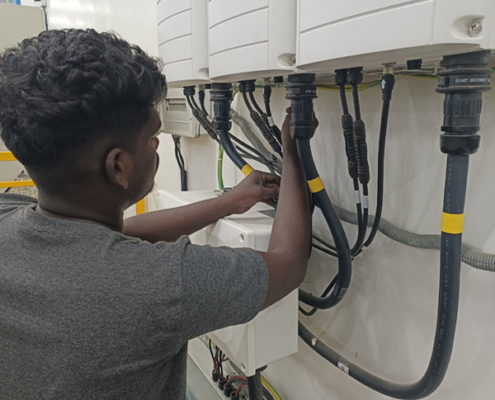

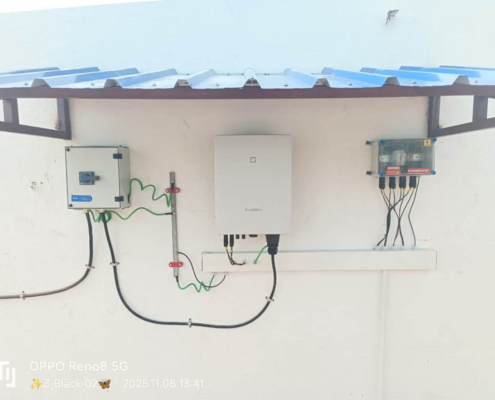

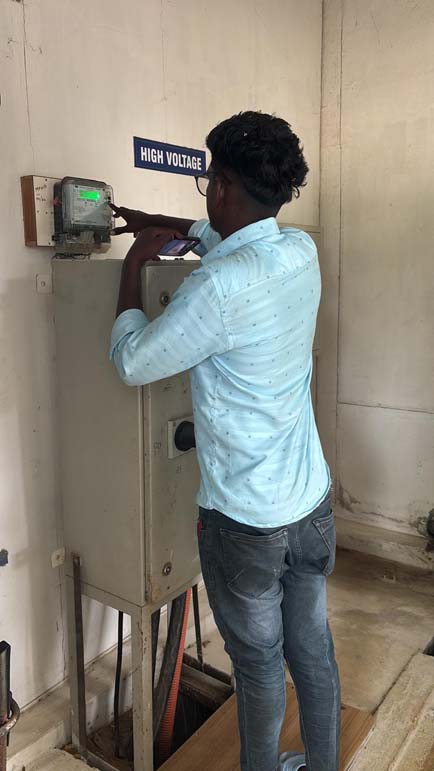

- Inverter: General checkup completed
- DC Fans: Checked; 2 fans cleaned
- Strings: All strings checked and found OK

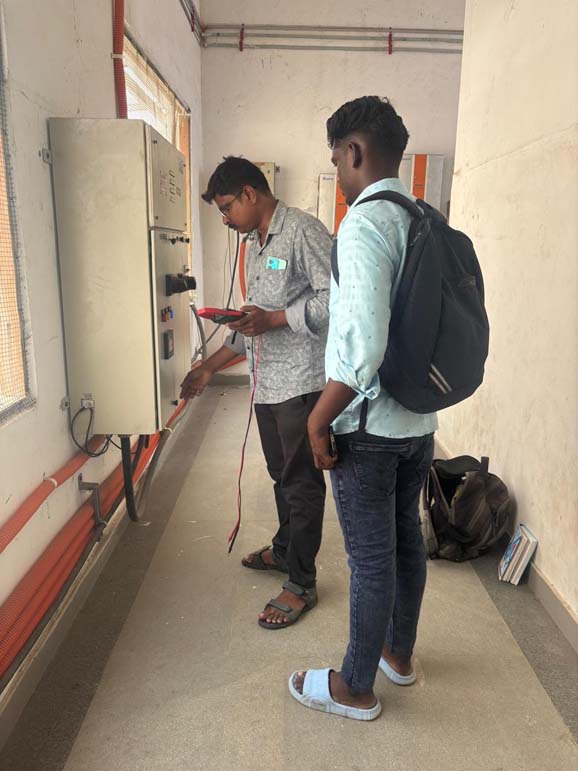

- System Parameters: All parameters verified and OK

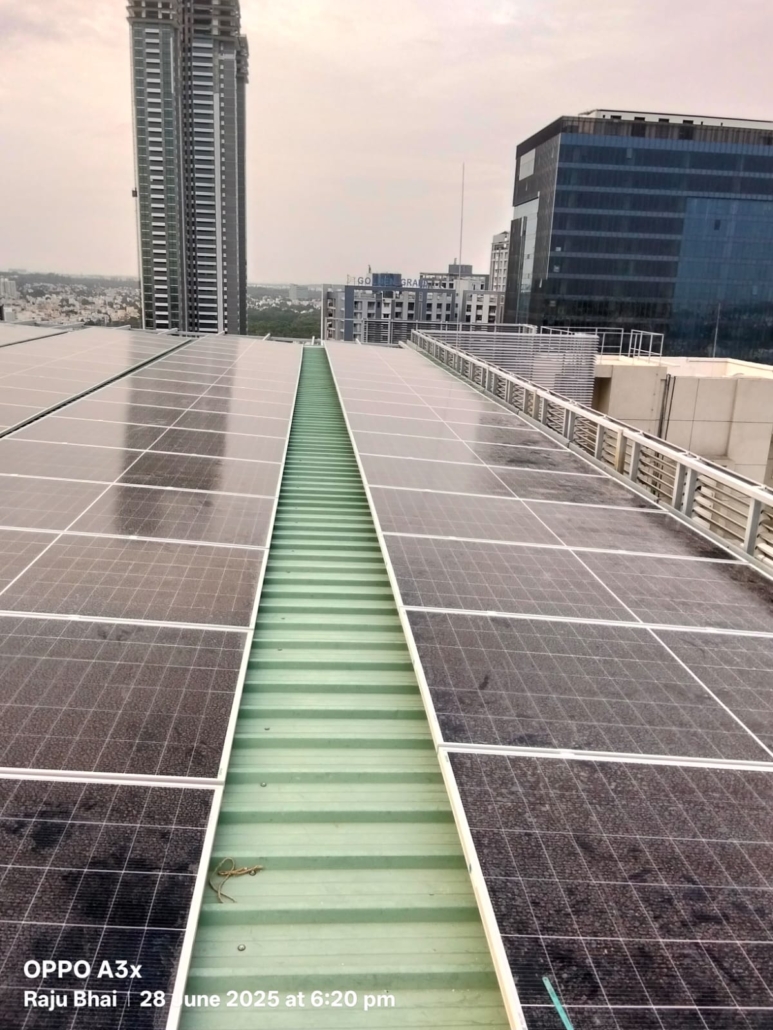

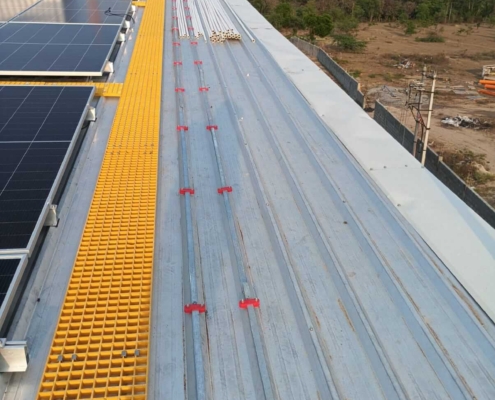

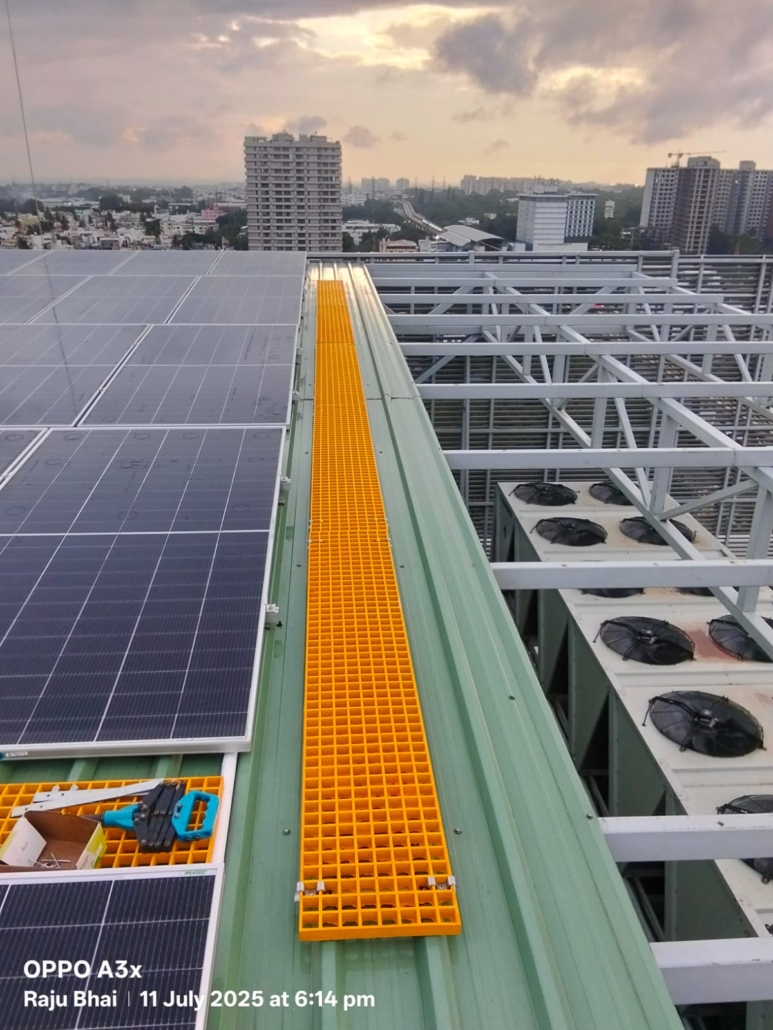

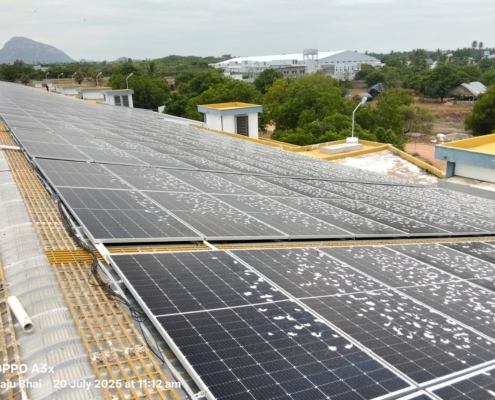

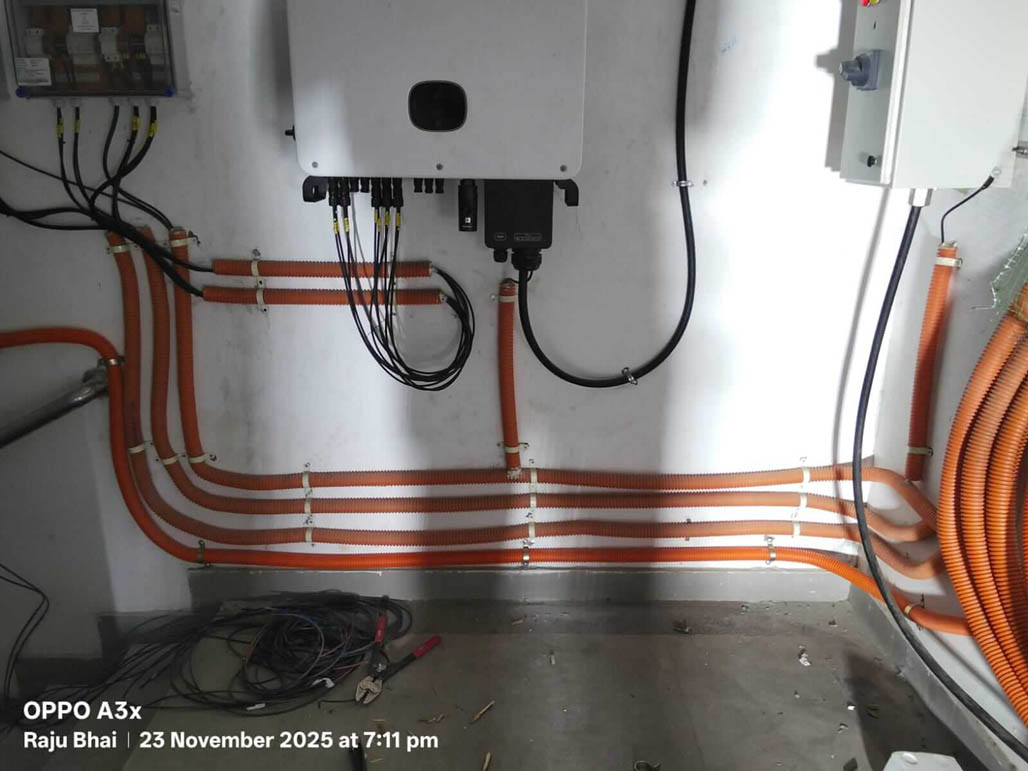

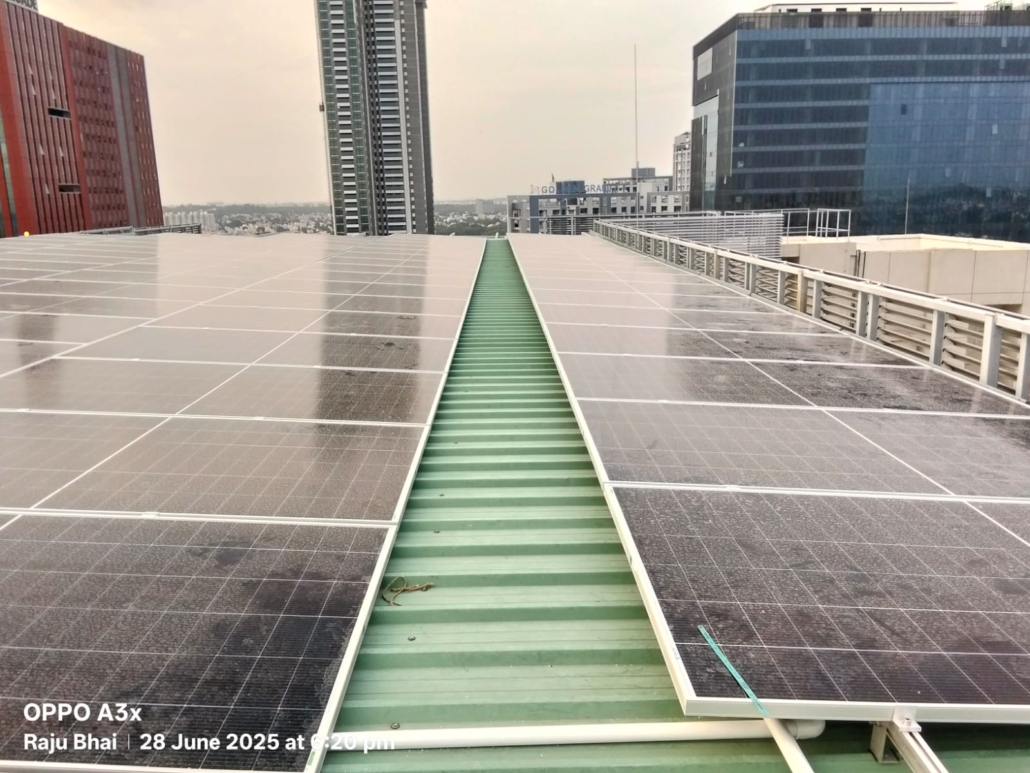

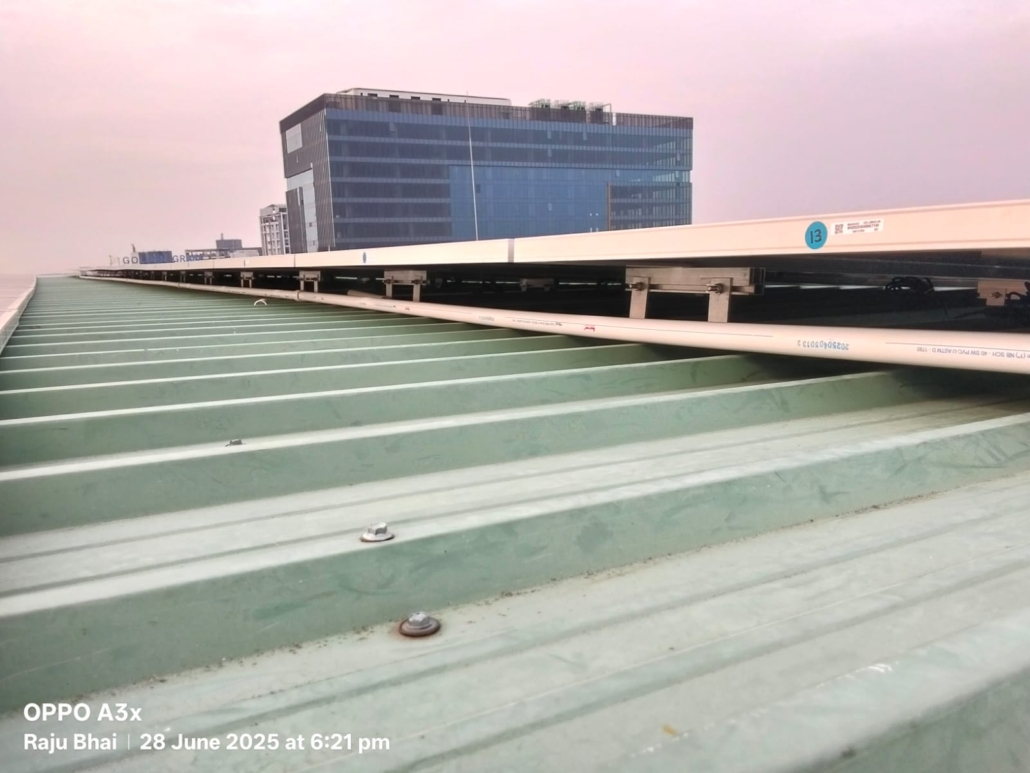

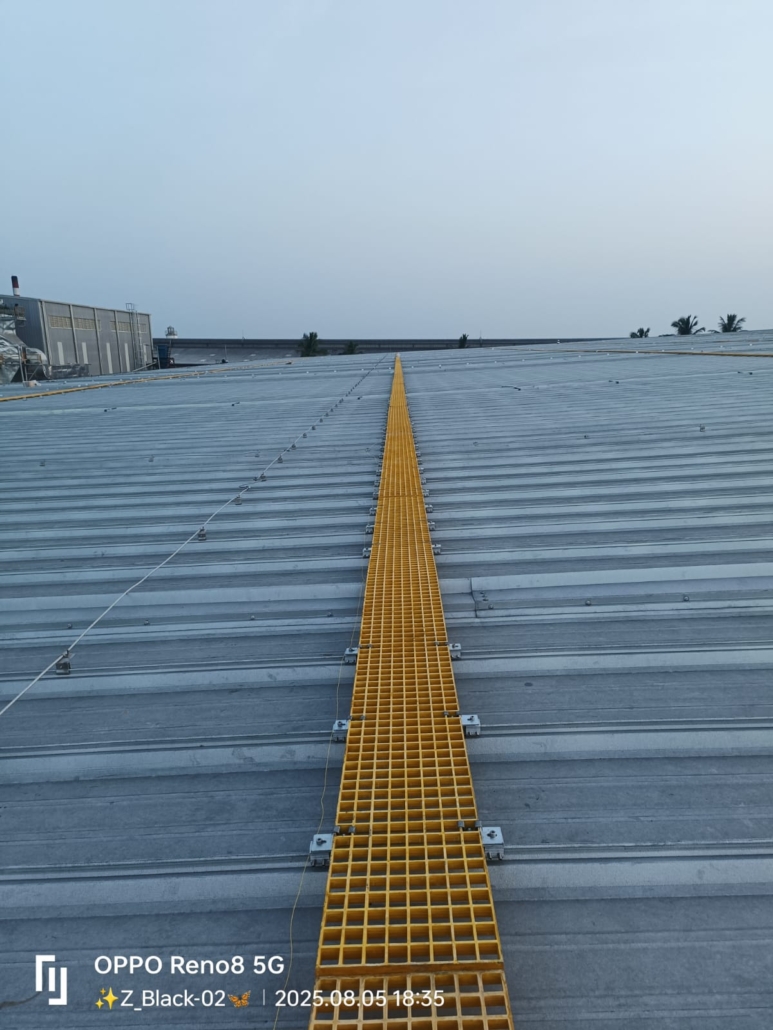

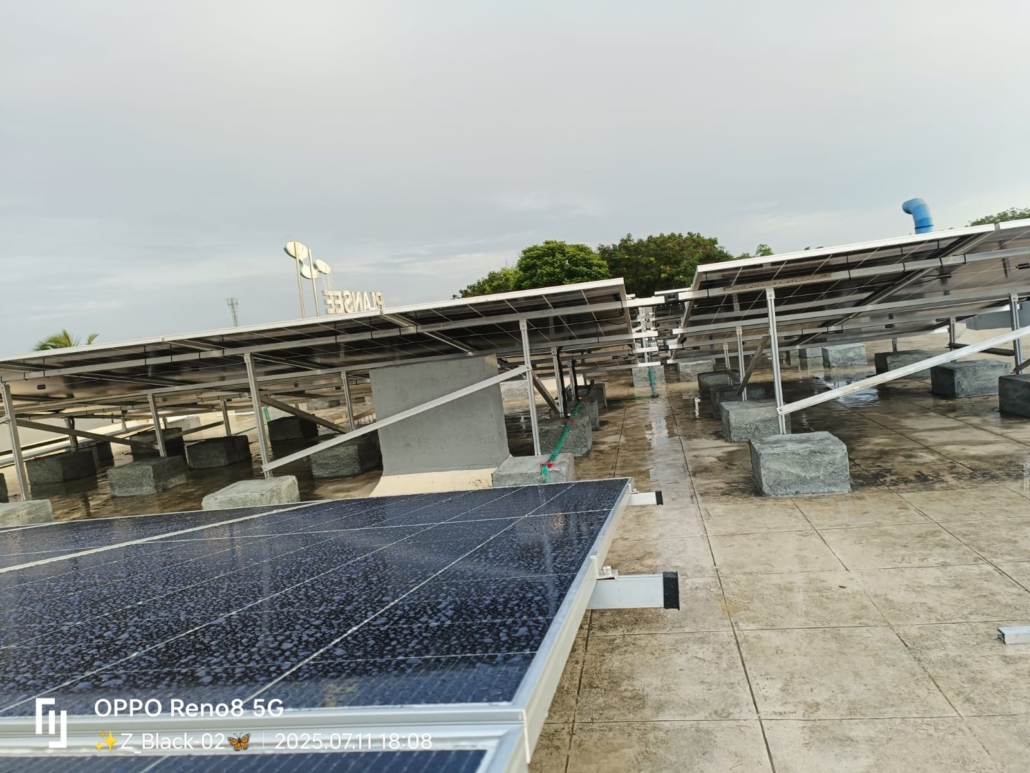

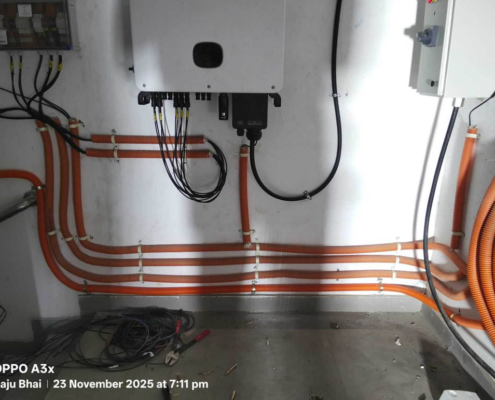

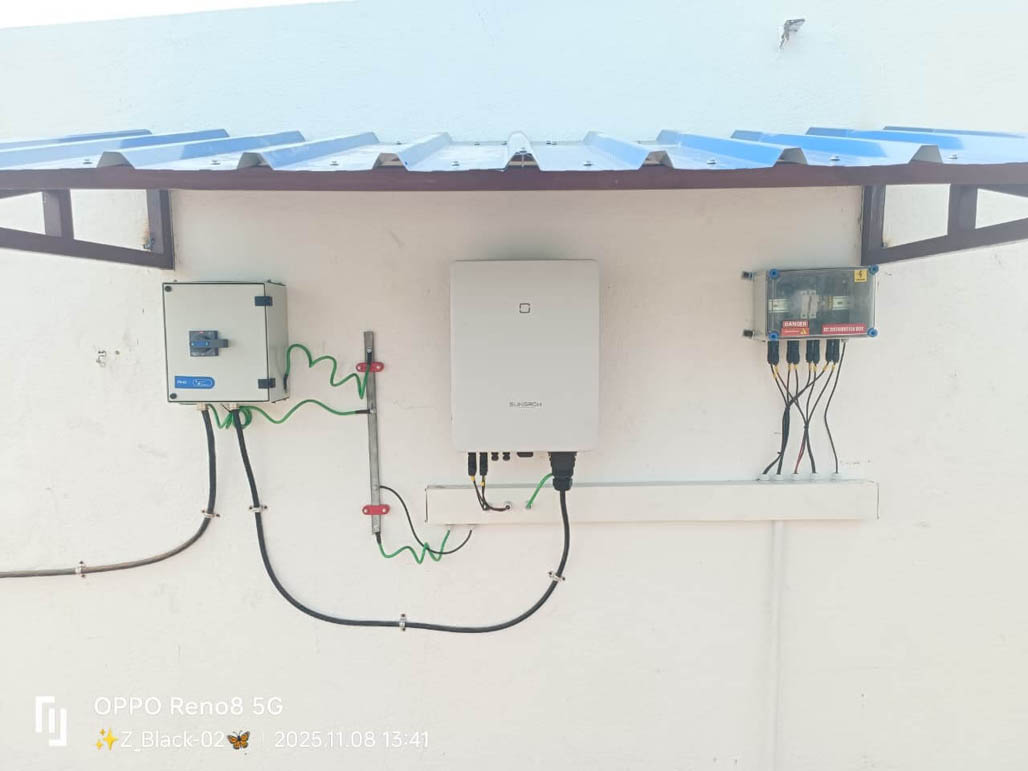

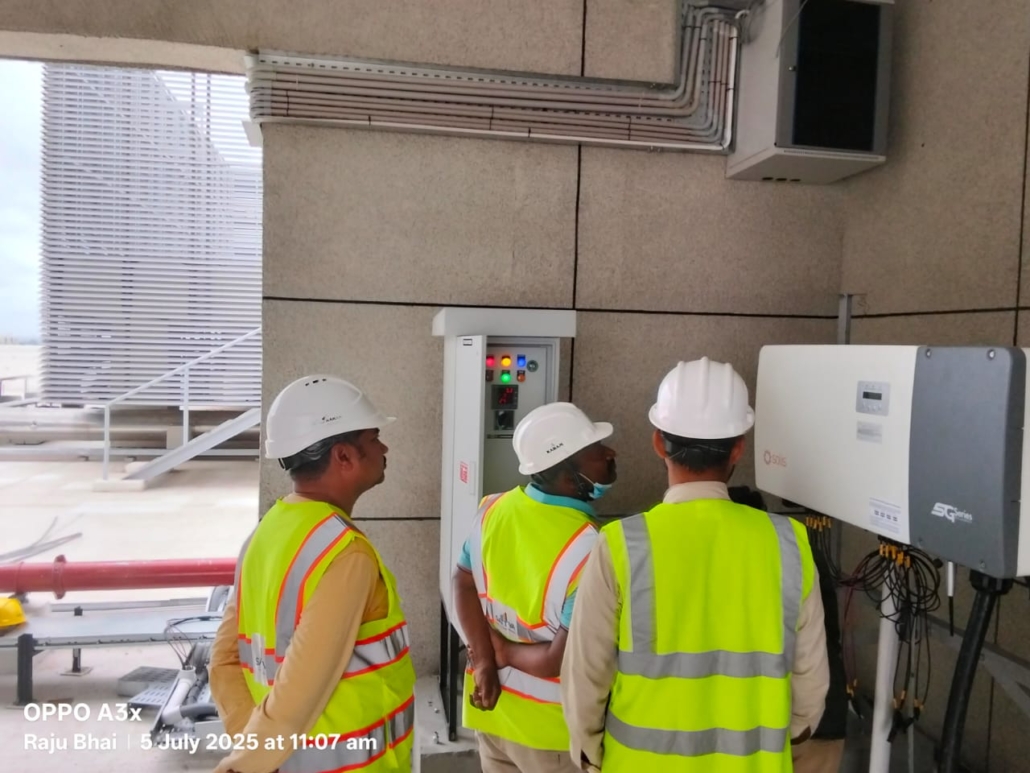

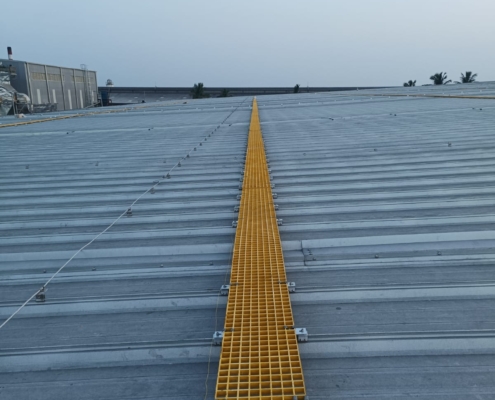

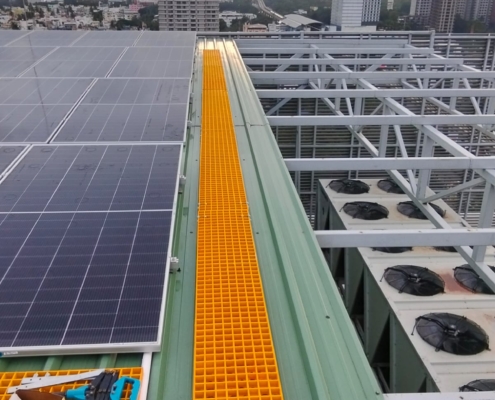

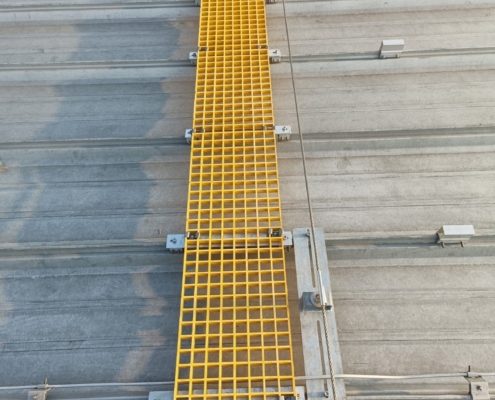

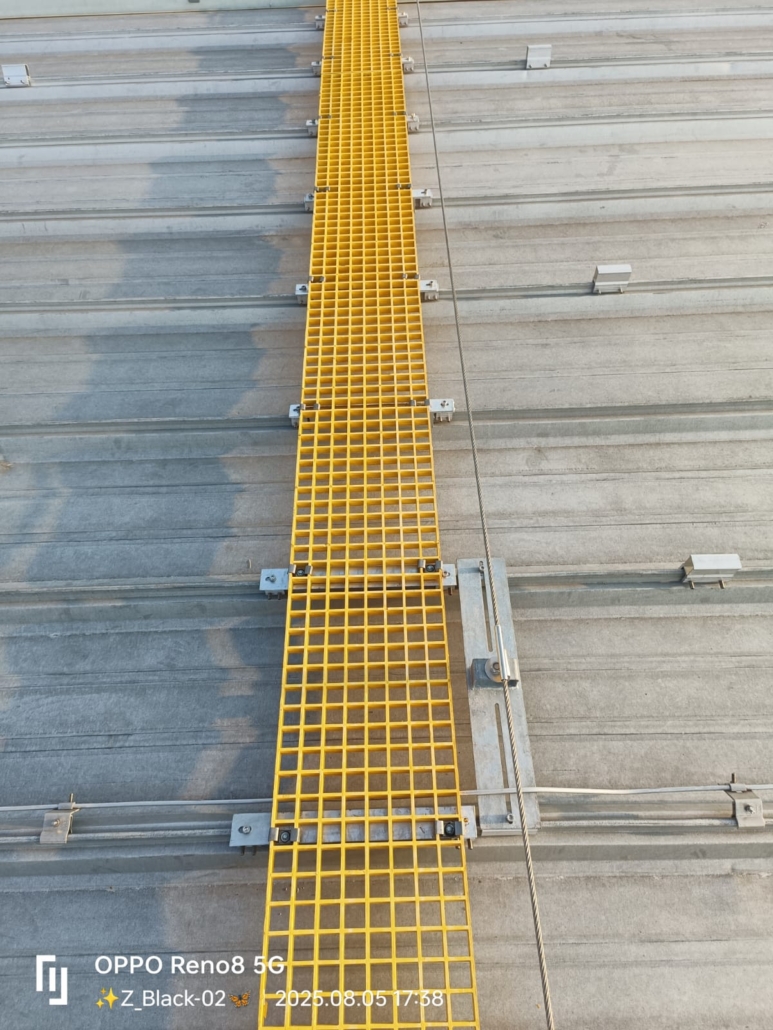

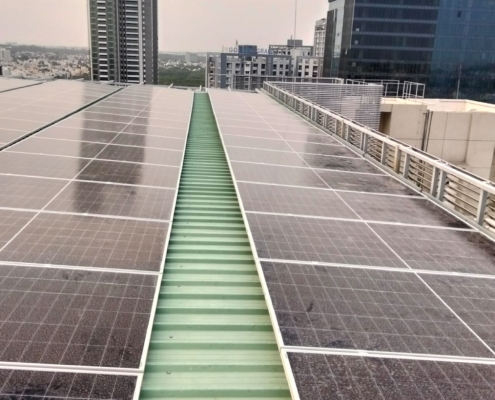

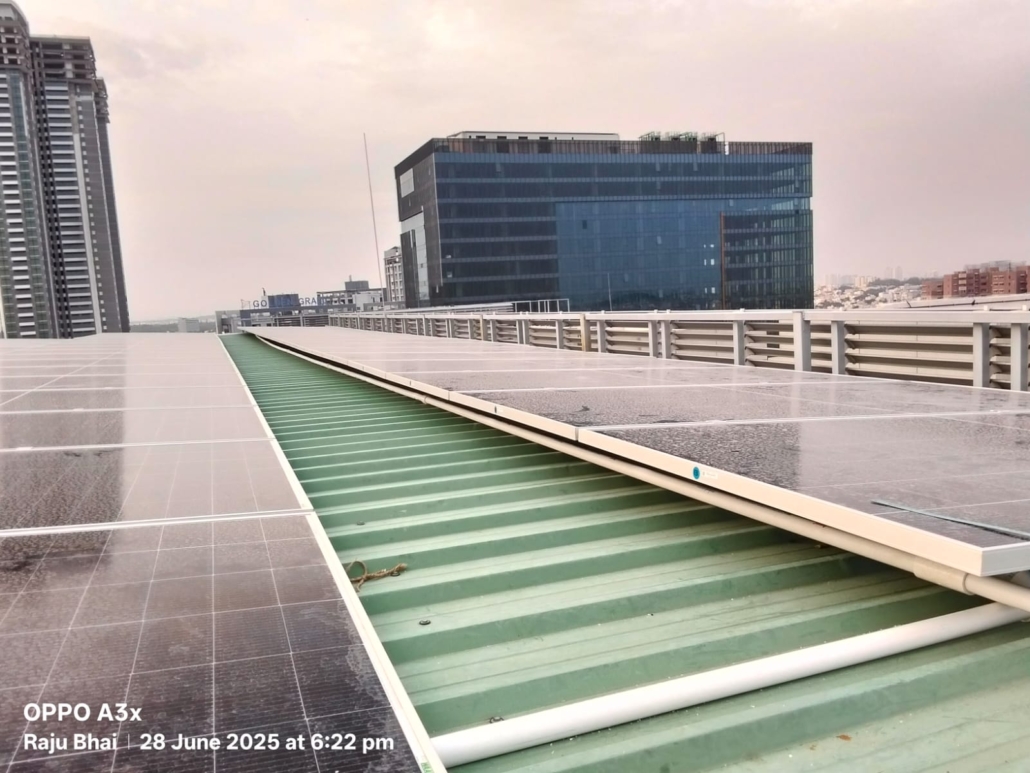

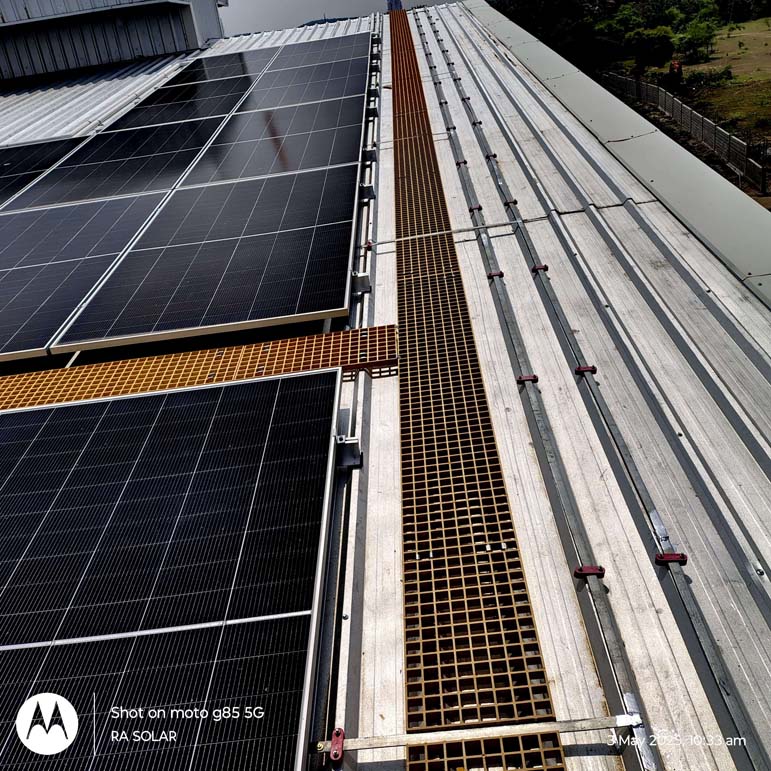

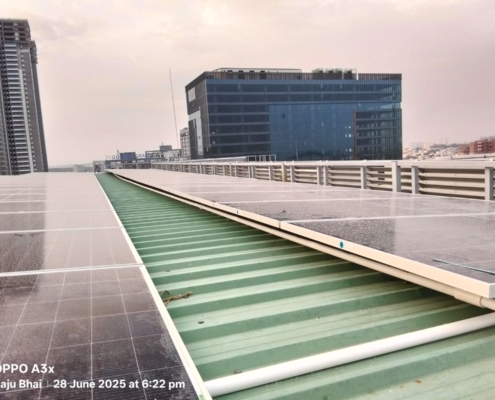

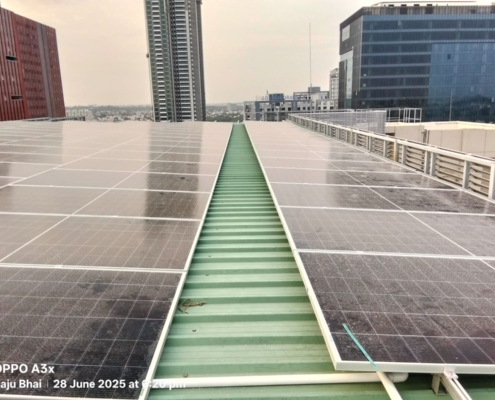

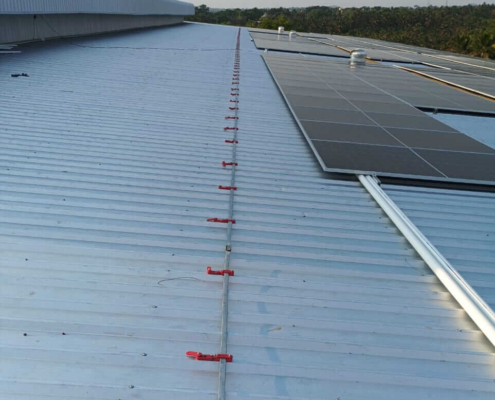

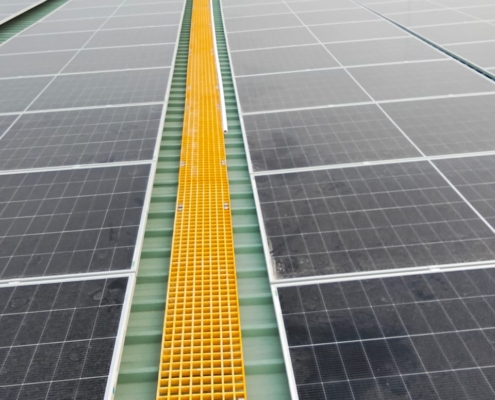

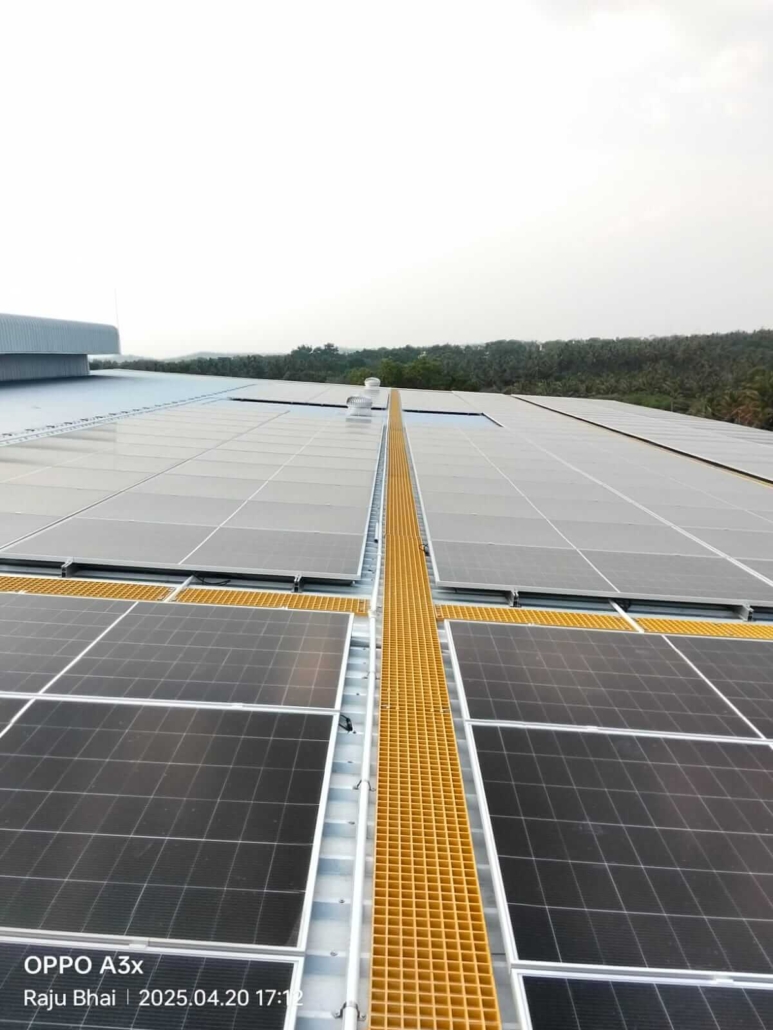

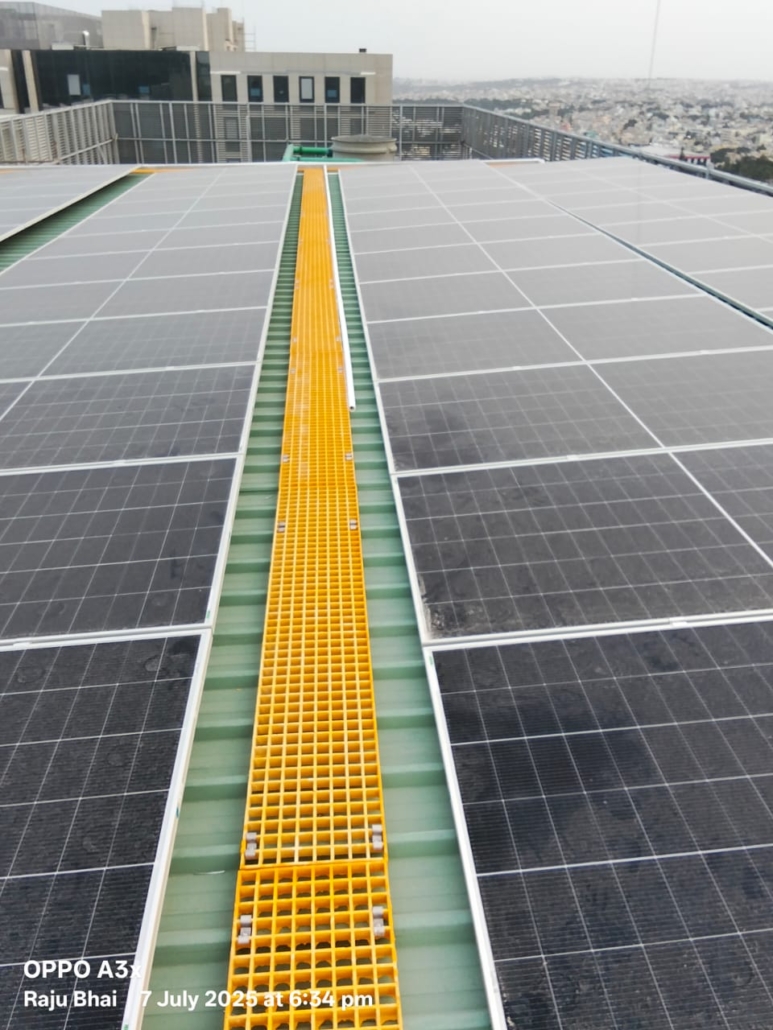

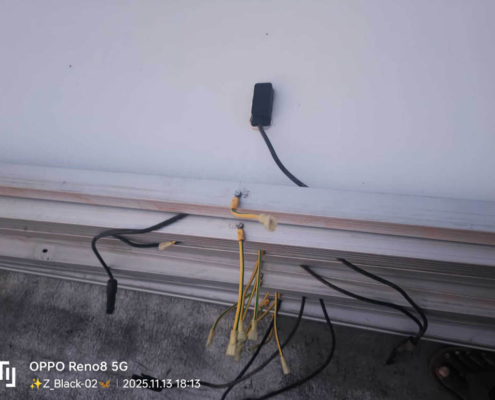

Conduit, Alignment & Cable Tray Works

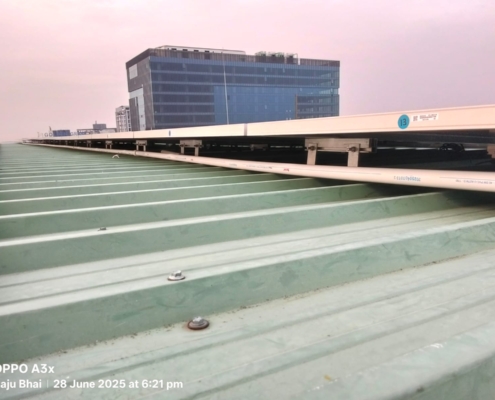

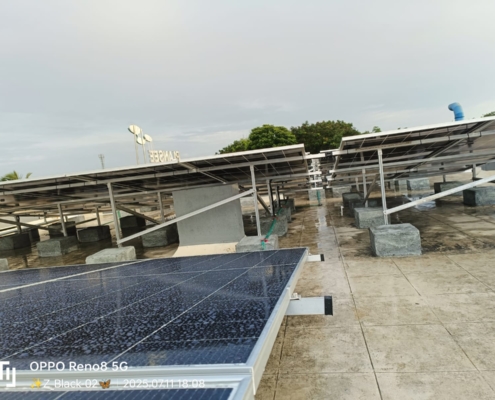

Tower A completed conduit pipe fixing and module alignment, while Tower B finished the cable tray installation work.

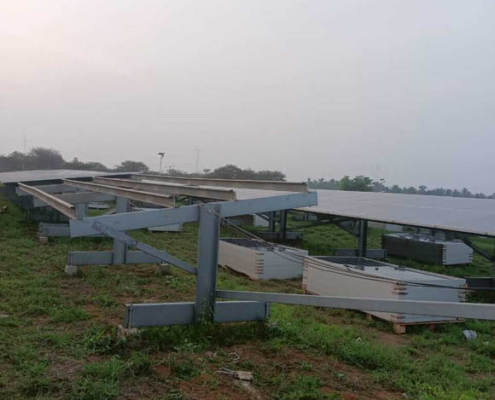

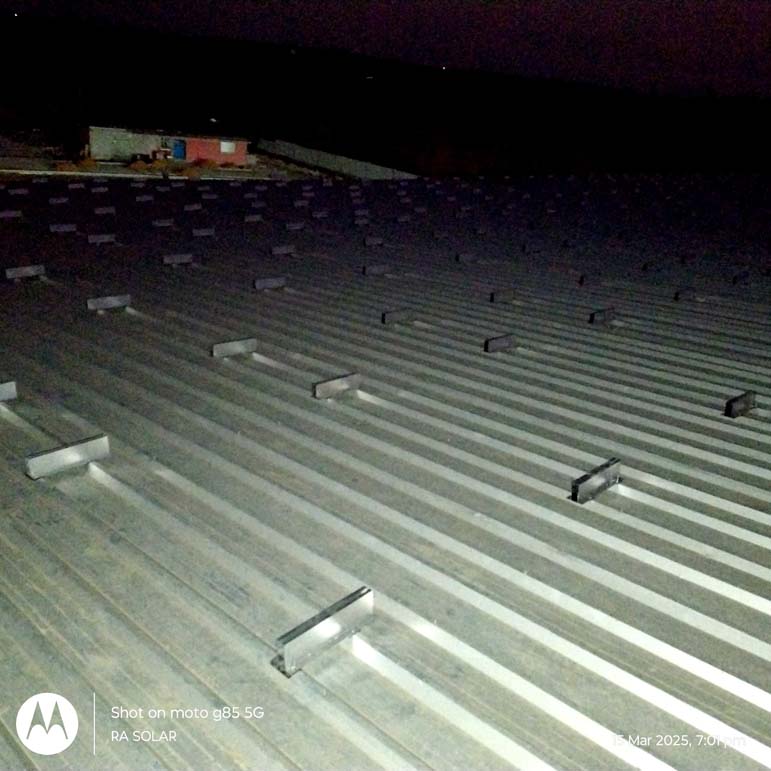

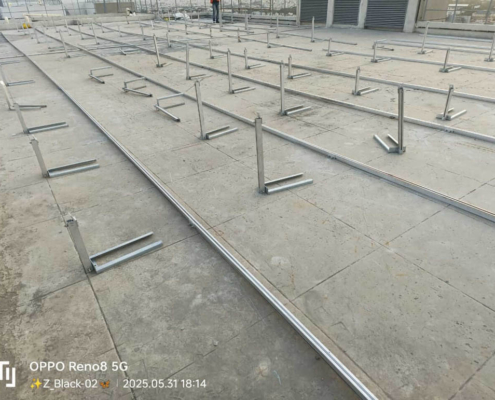

Column Post Shortage Update
Shortage identified: 10 long column posts and 10 short column posts.
